In April 2024, voters in the Hamilton School District approved two referendum questions that allow for $25 million in facilities projects and fund $7.6 million of operational costs on a recurring basis. This community support allows the district to continue providing an outstanding education for students while also accommodating our growing enrollment.

Projects
Marcy Elementary School traffic reconfiguration * PROJECT COMPLETE *
PROJECT COMPLETE

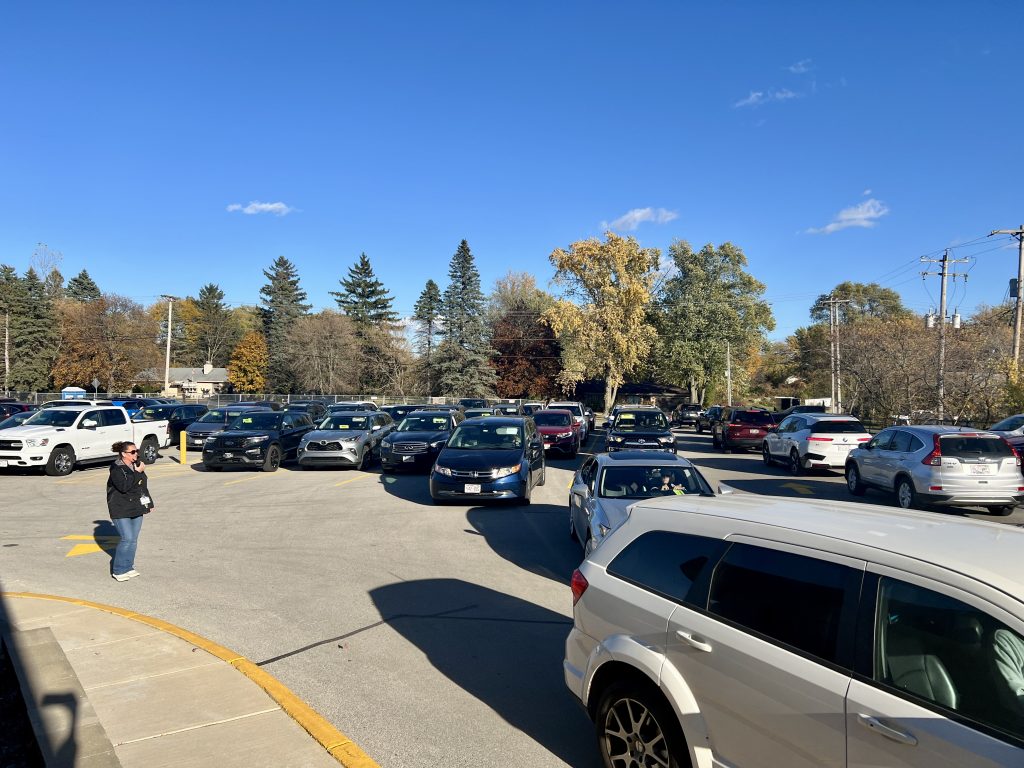

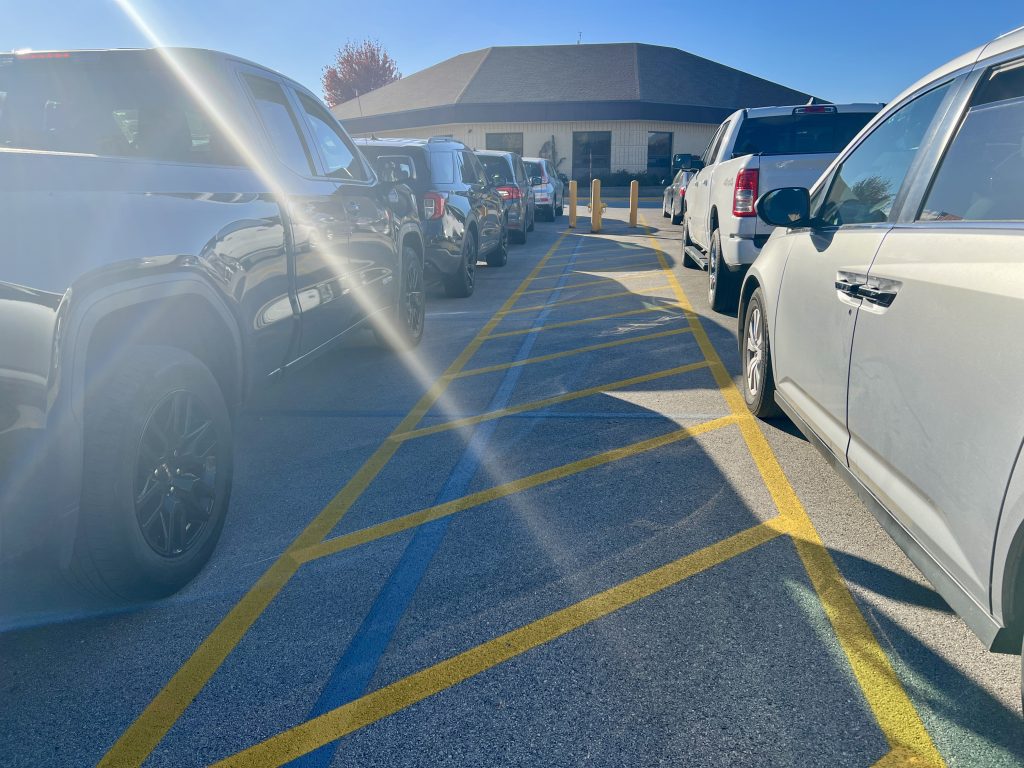

On October 21, 2024 families began using the new 7 lane pick-up/drop-off traffic pattern. This has eliminated back ups on Marcy Road. Previous procedures included only 5 lanes without pavement markings. Bus traffic and parent vehicles are now fully separated by a fence to increase safety during busy arrival and dismissal times. The now fully fenced-in playground area is safe for children and separates morning bus drop off and play areas.



Hamilton High School cafeteria * PROJECT COMPLETE *
October 2024 – June 2025
Scheduled to be complete before the 2025-26 school year begins


















UPDATES :

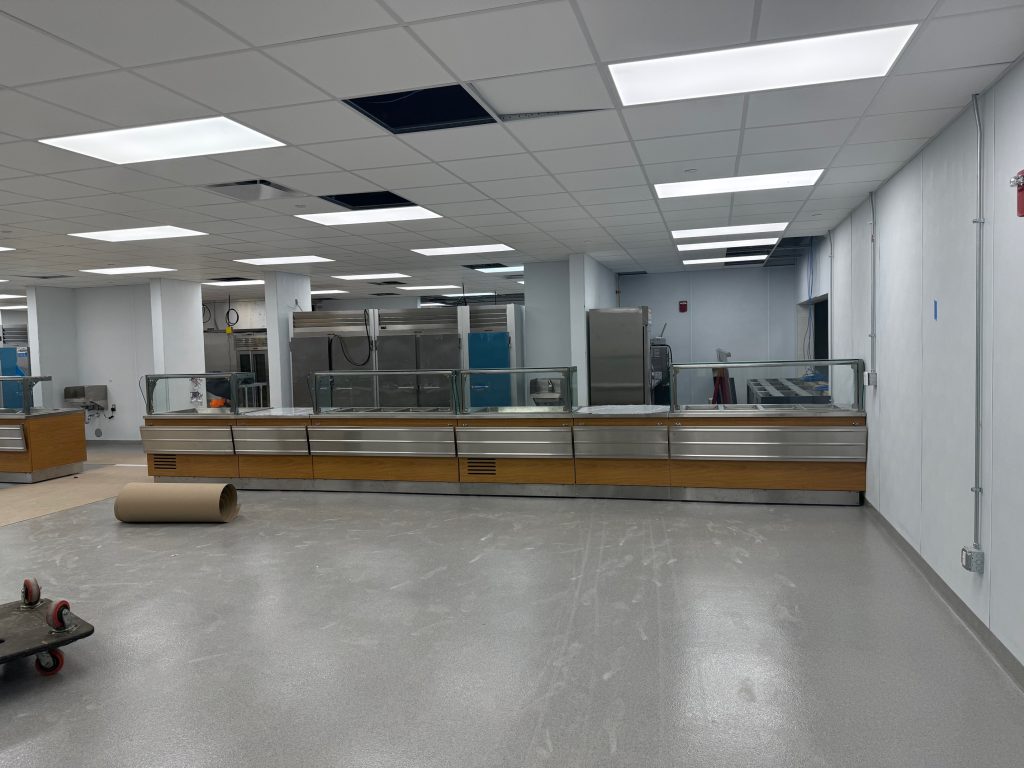

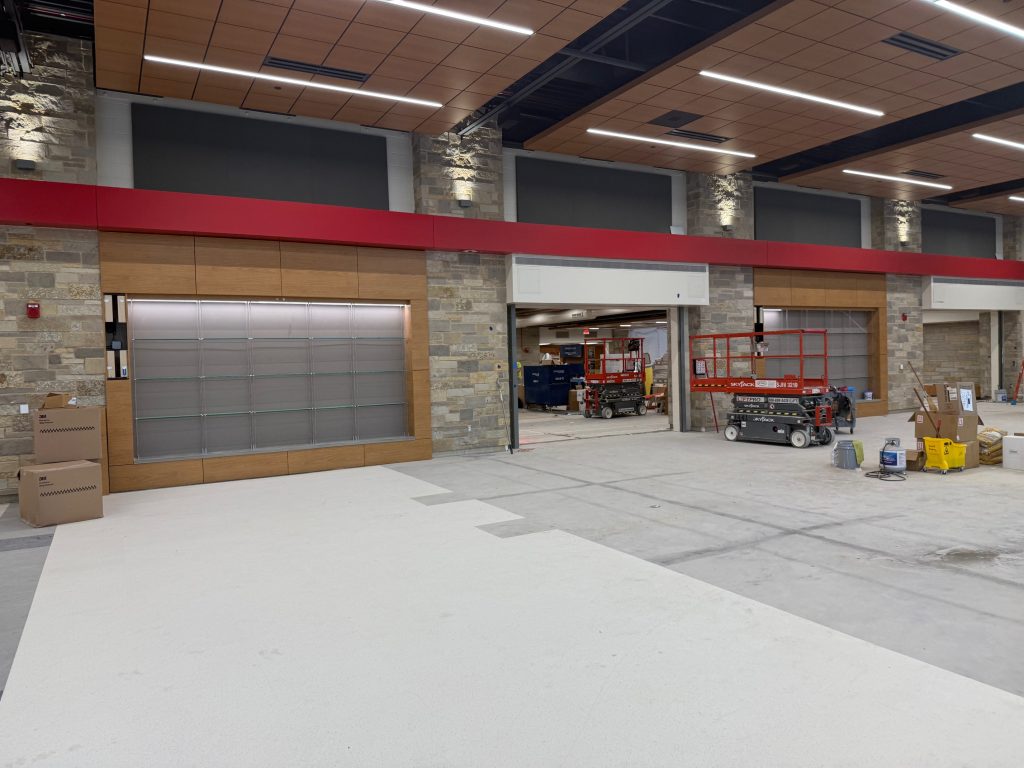

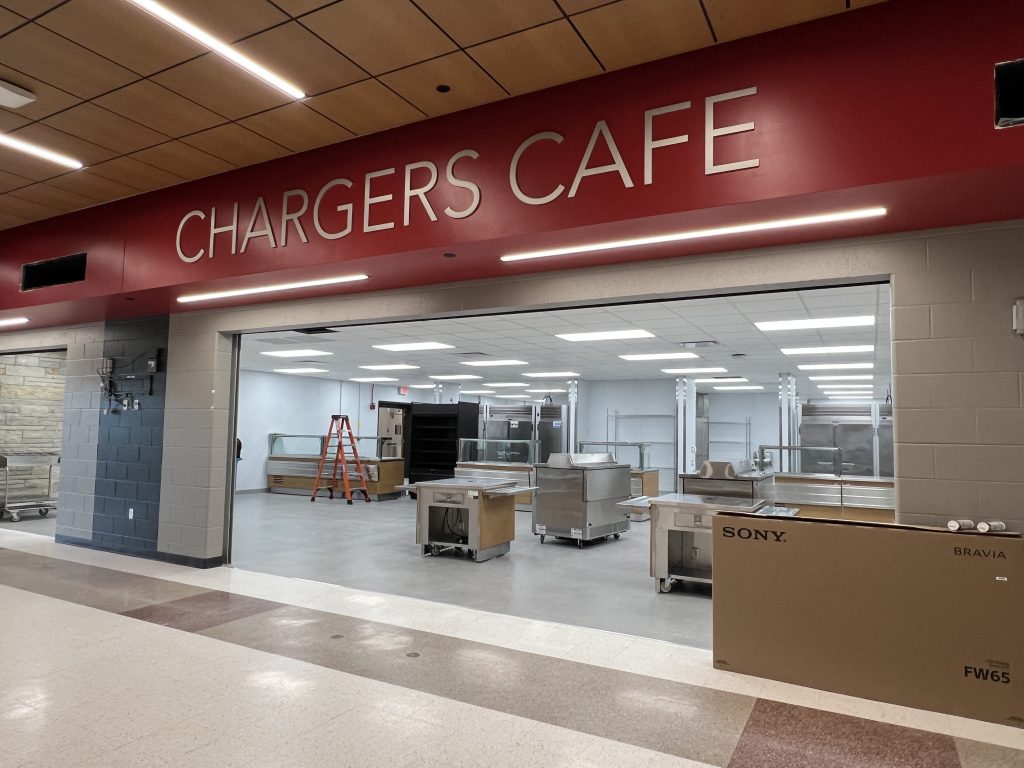

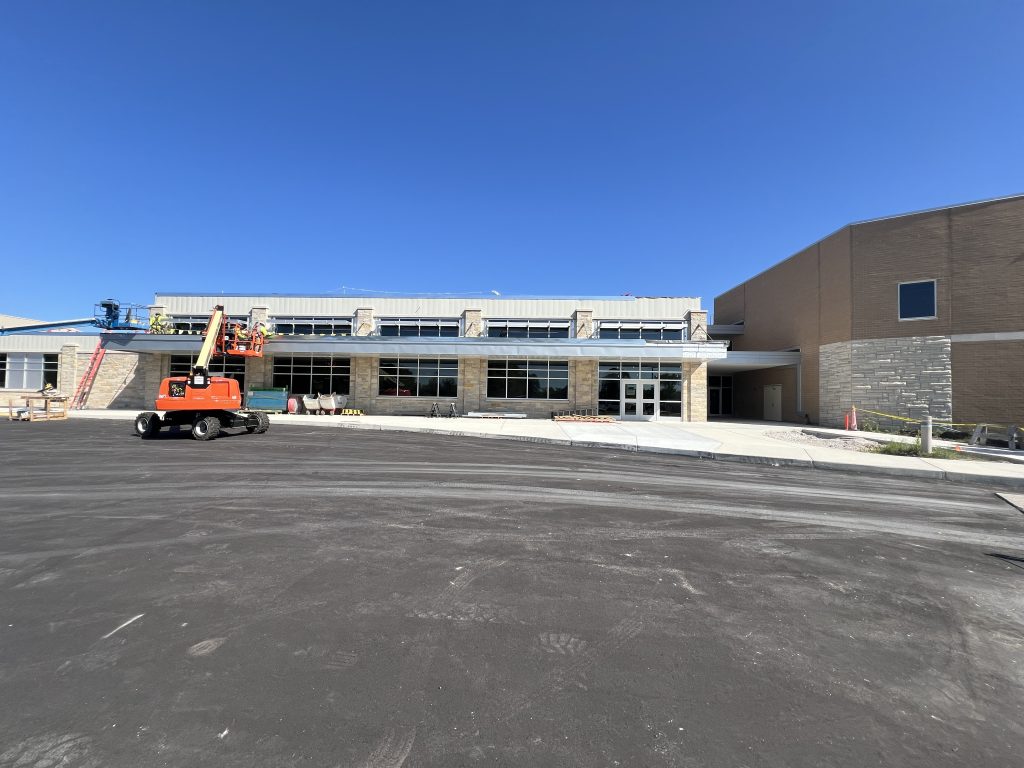

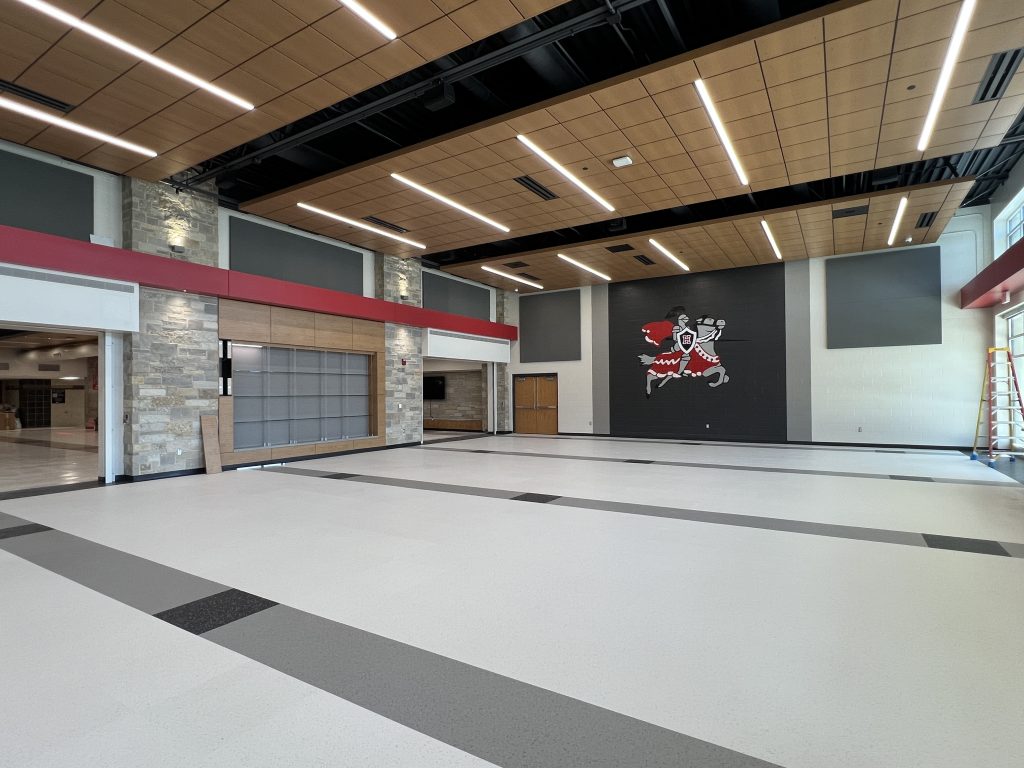

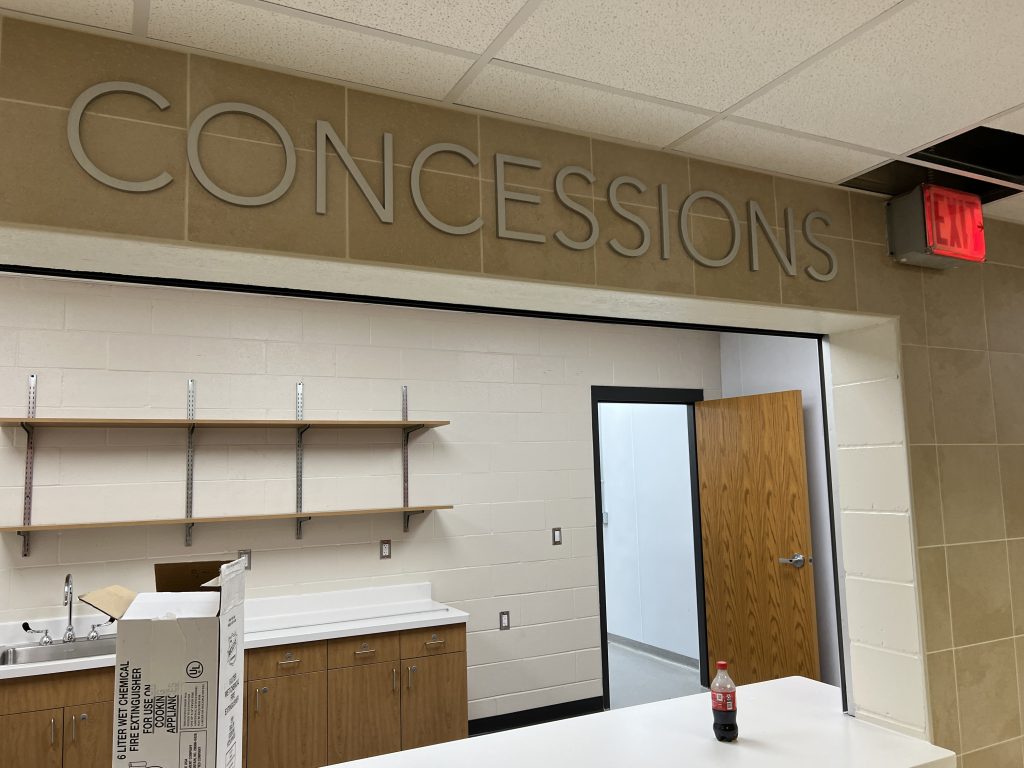

- Watch August 2025 Hamilton High School Cafeteria Project Update
- Watch July 2025 Hamilton High School Cafeteria Project Update

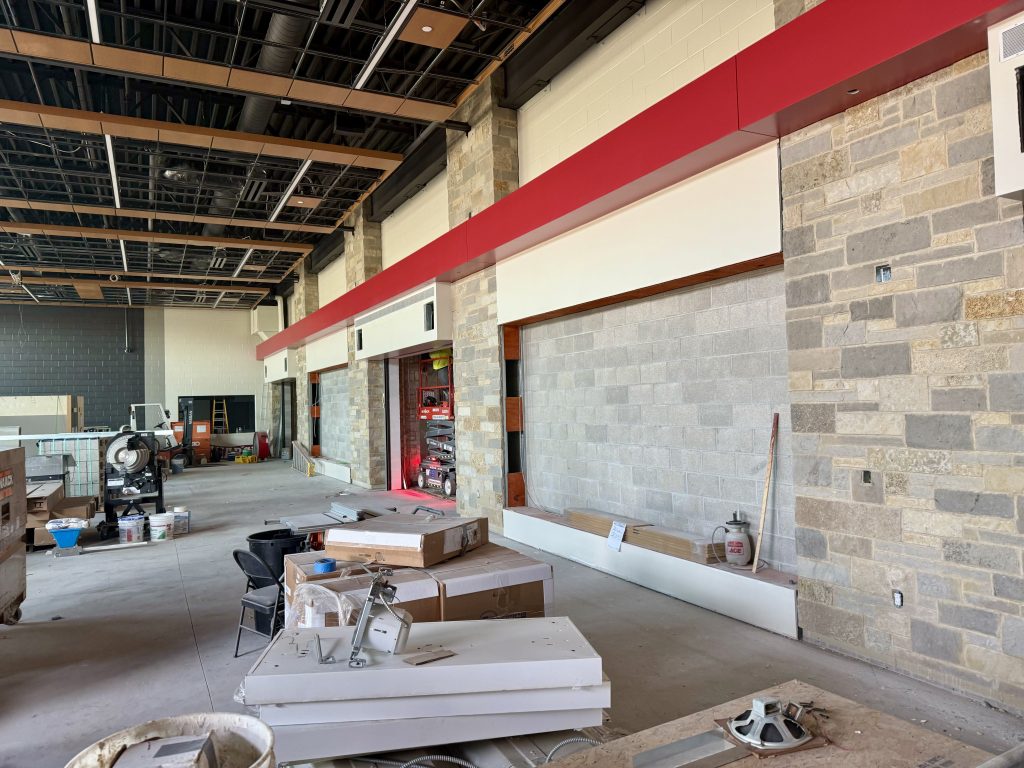

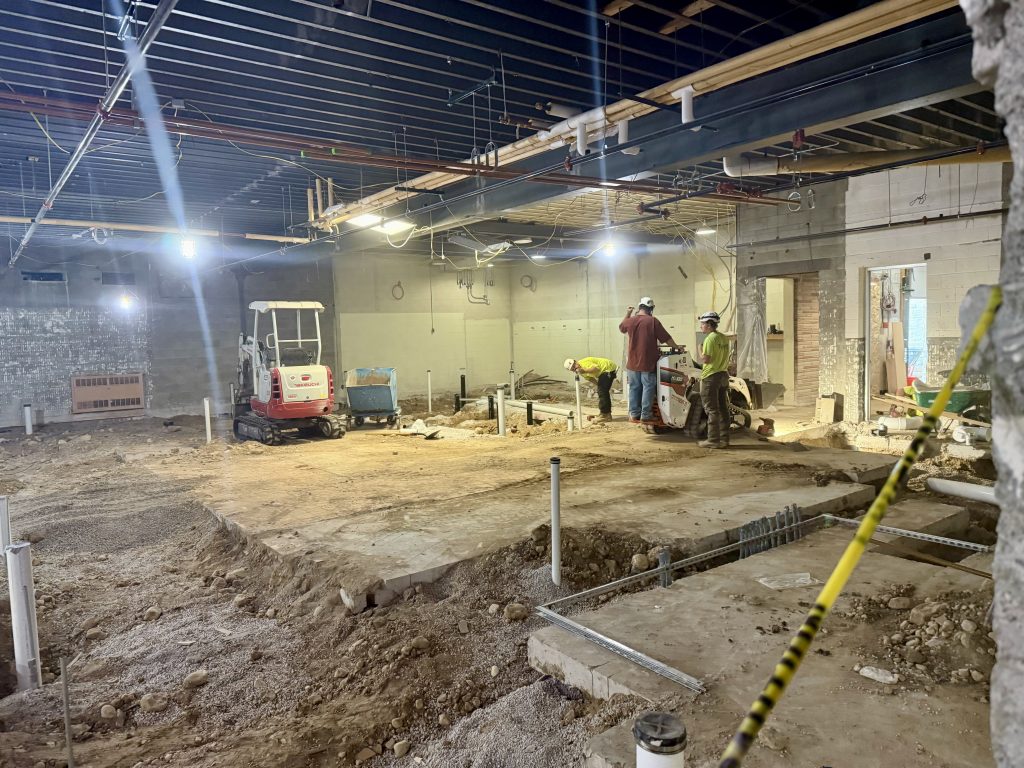

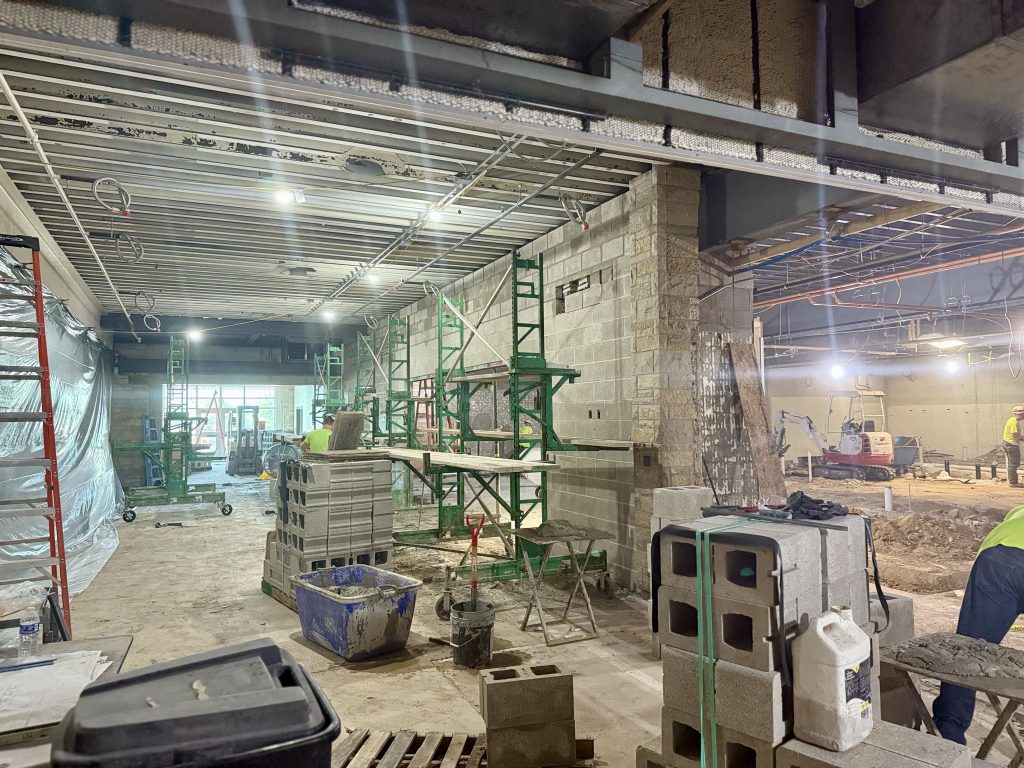

- May 2025 – drywall begins, Lannon stone veneer completion, freezer installation, exterior metal panels

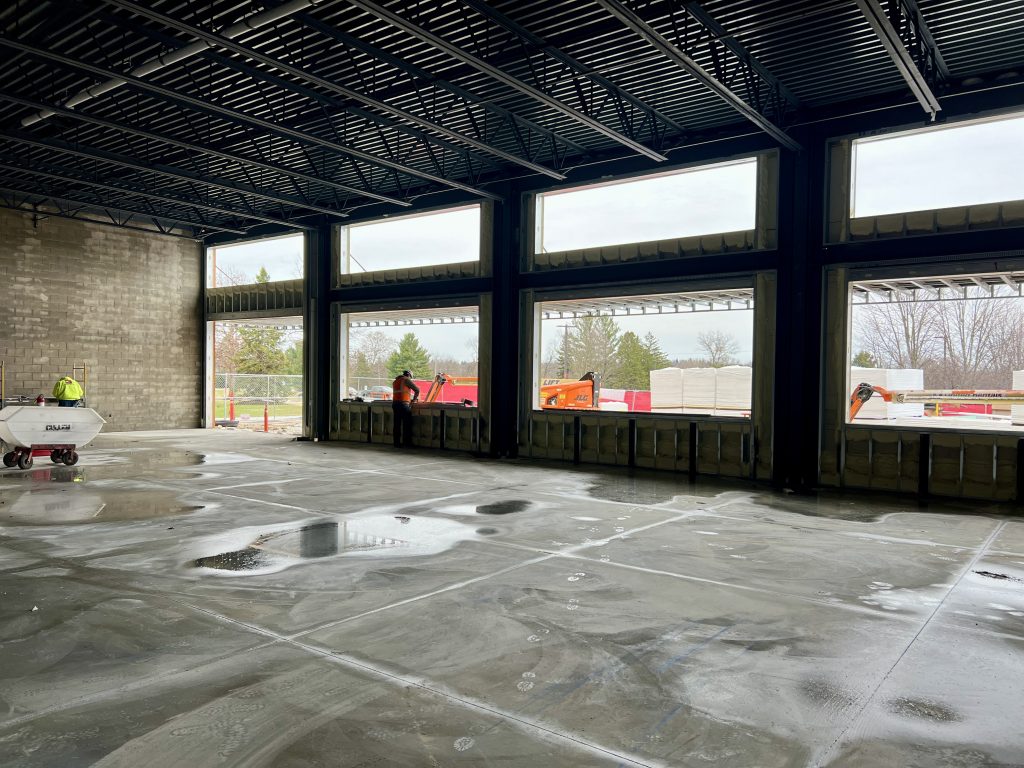

- Watch April 2025 Hamilton High School Cafeteria Project Update

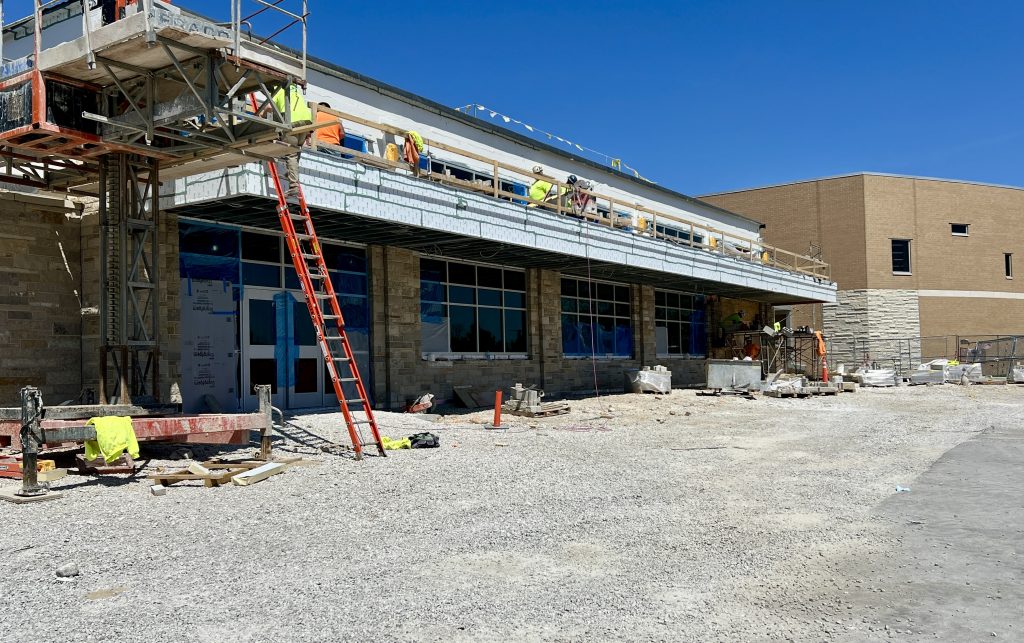

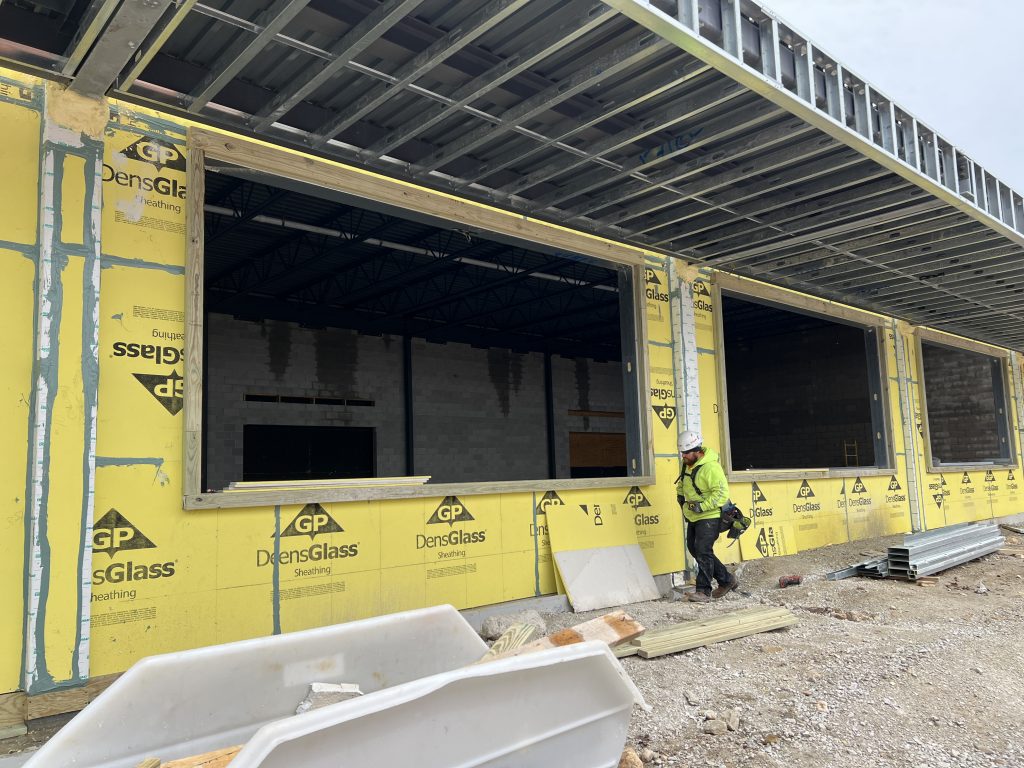

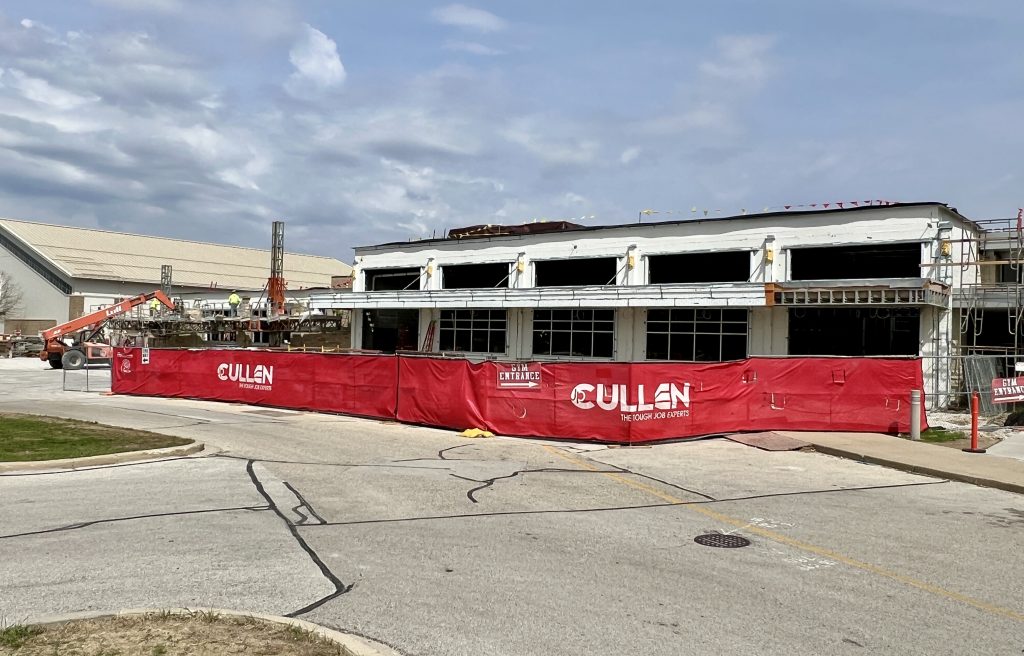

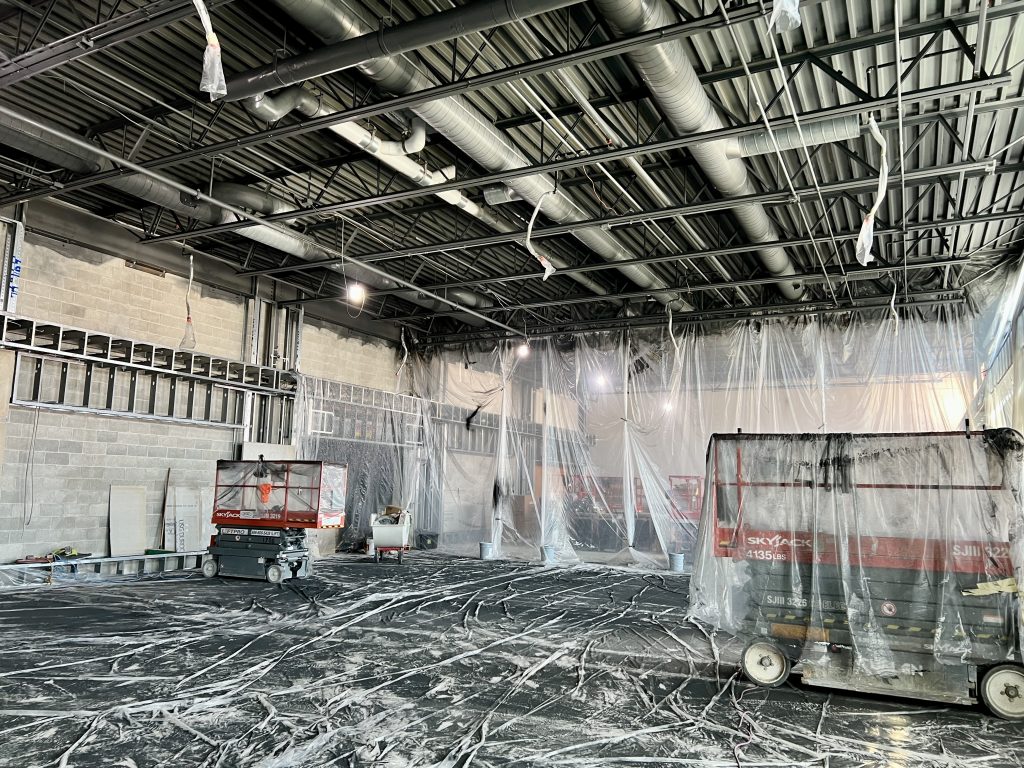

- April 2025 – roofing, HVAC, installation of Lannon stone exterior, fire suppression and windows

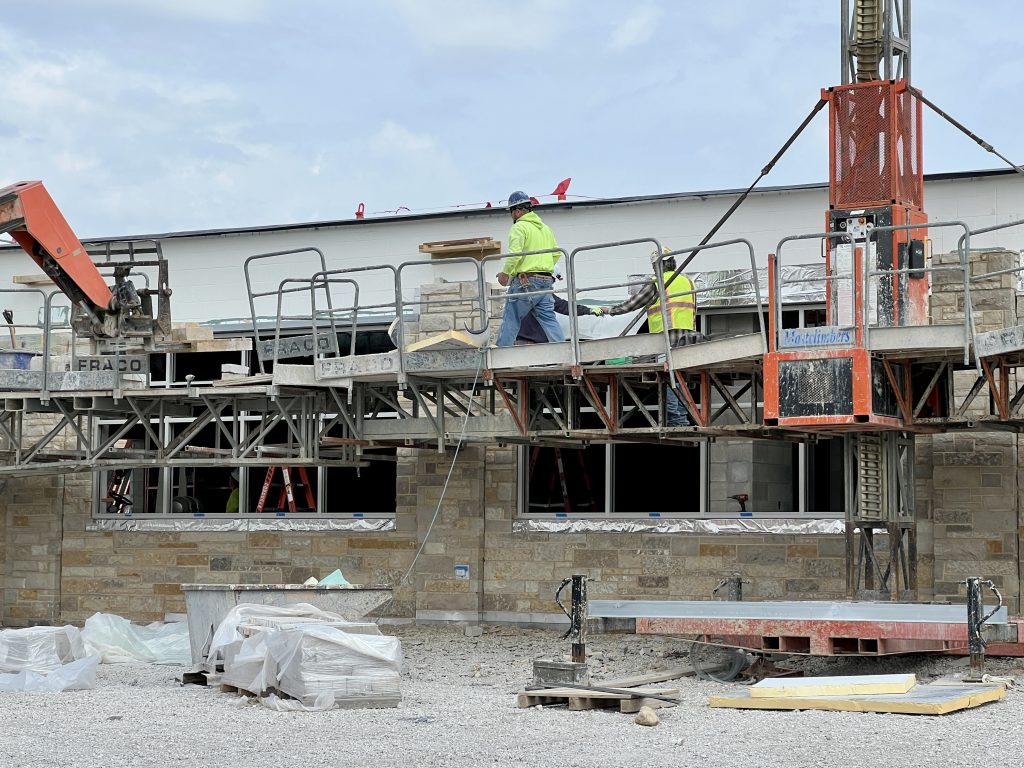

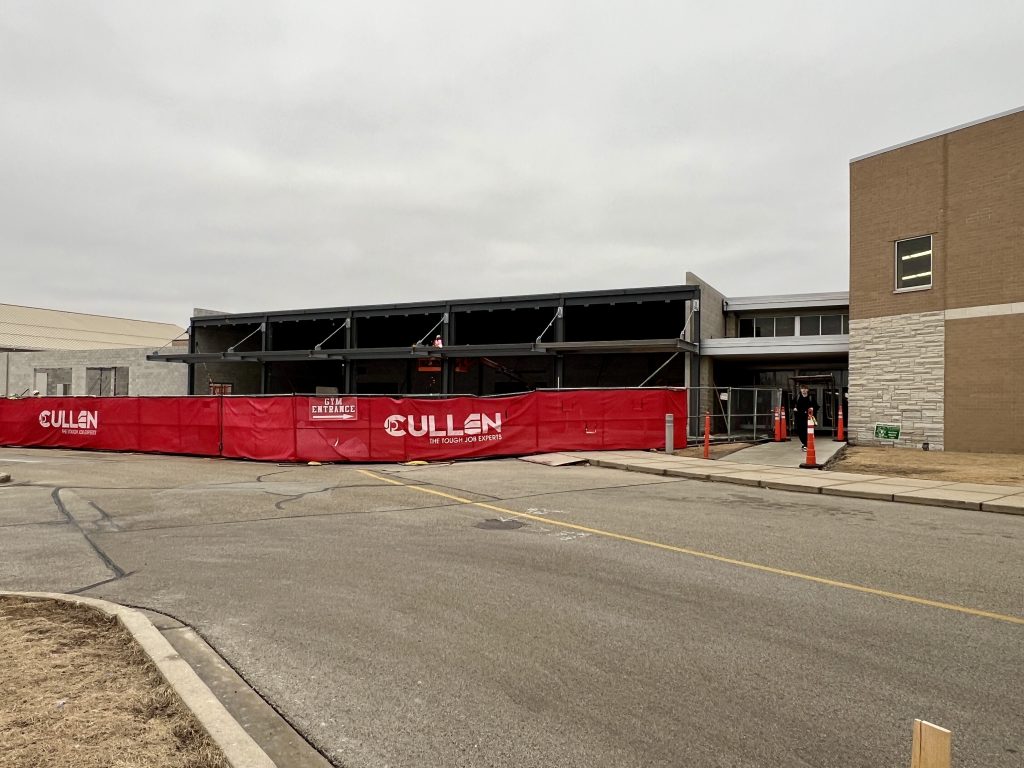

- March 2025 – steel structure completed, footings poured

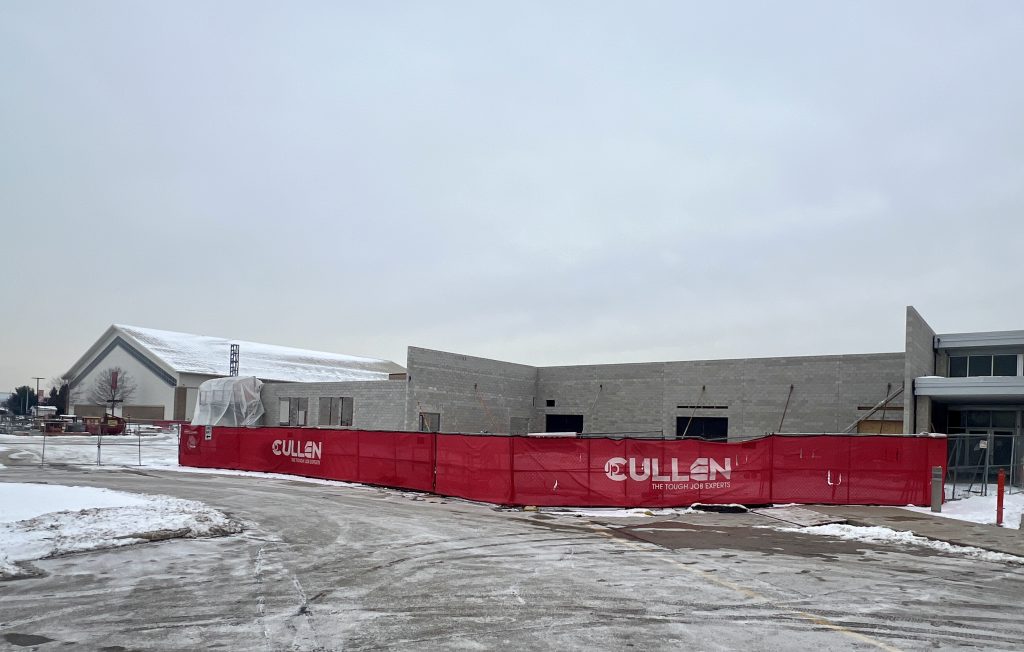

- Feb. 2025 – exterior walls completed
- Jan. 2025 – pour slab on grade, exterior walls
- Dec. 2024 – underground rough-ins
- Oct. 2024 – construction fence installed

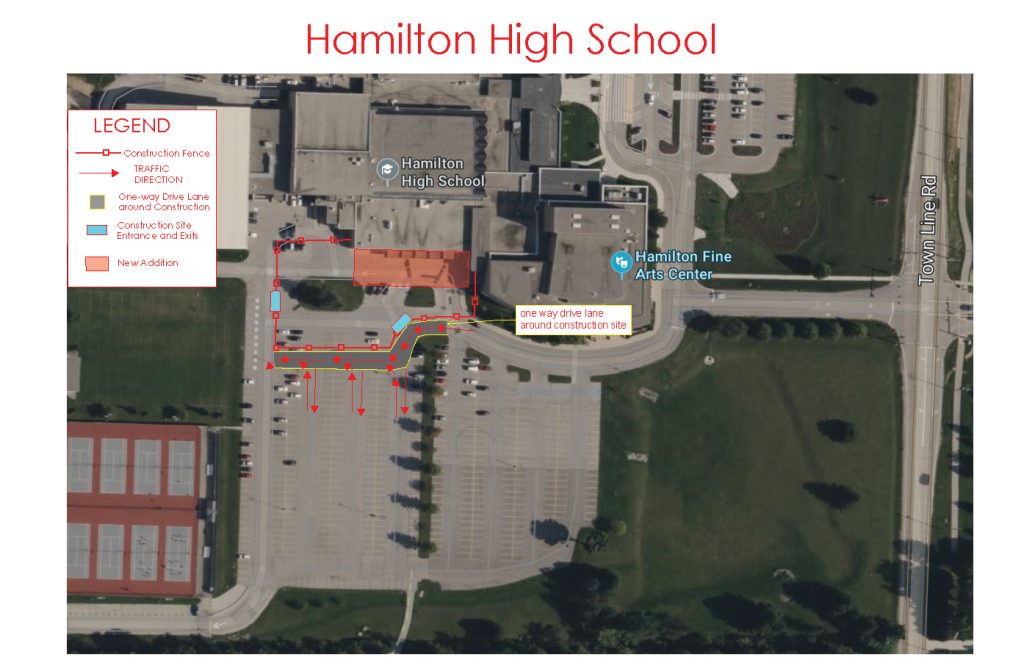

You are invited to review the project overview document for additional information about the cafeteria addition project at HHS.

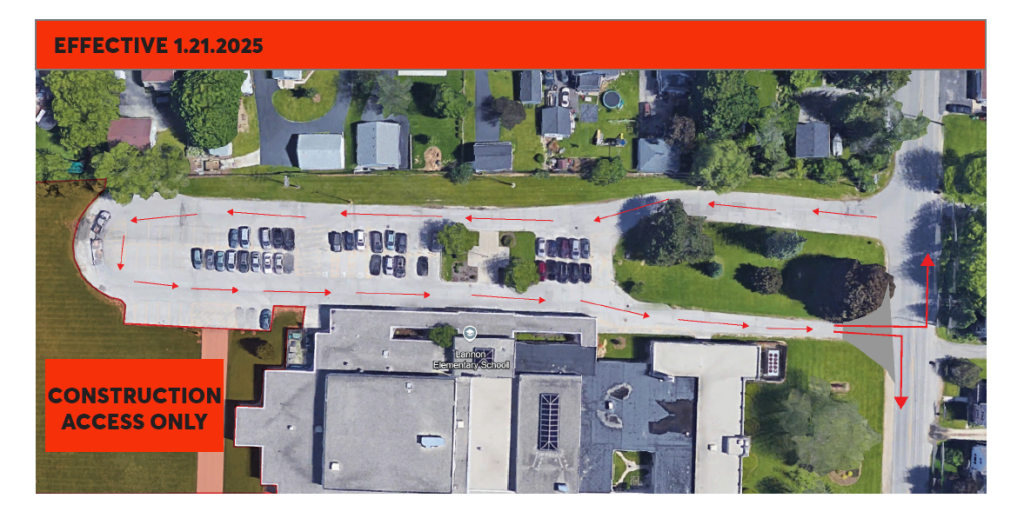

Lannon Elementary School addition/traffic reconfiguration * PROJECT COMPLETE *
December 2024- August 2025
Scheduled to be complete before the 2025-26 school year begins











UPDATES :

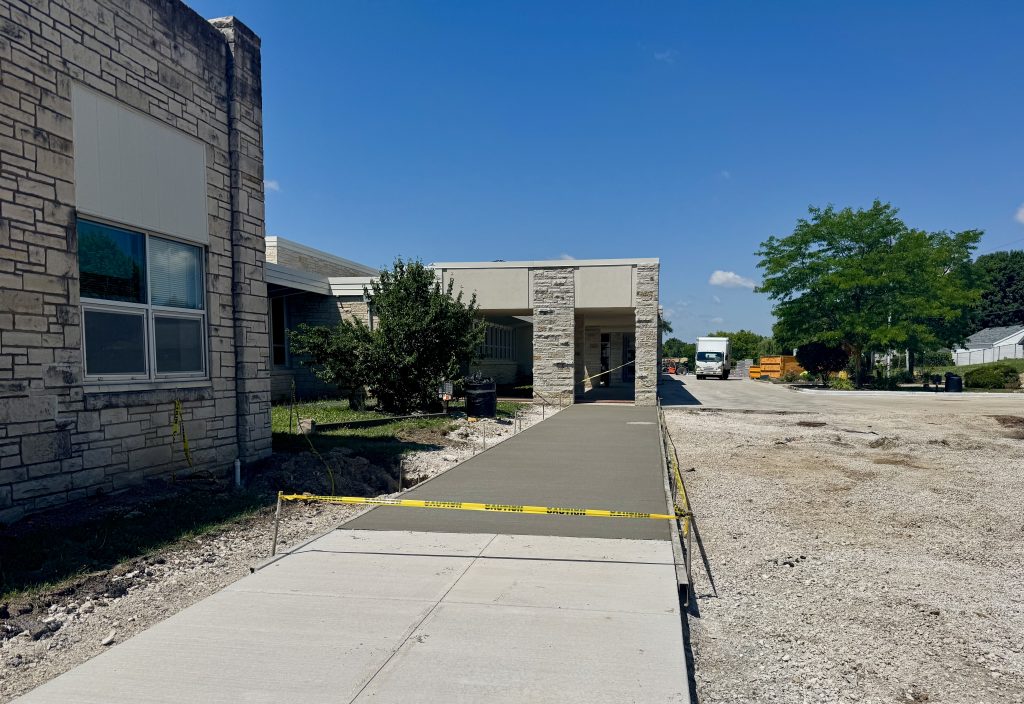

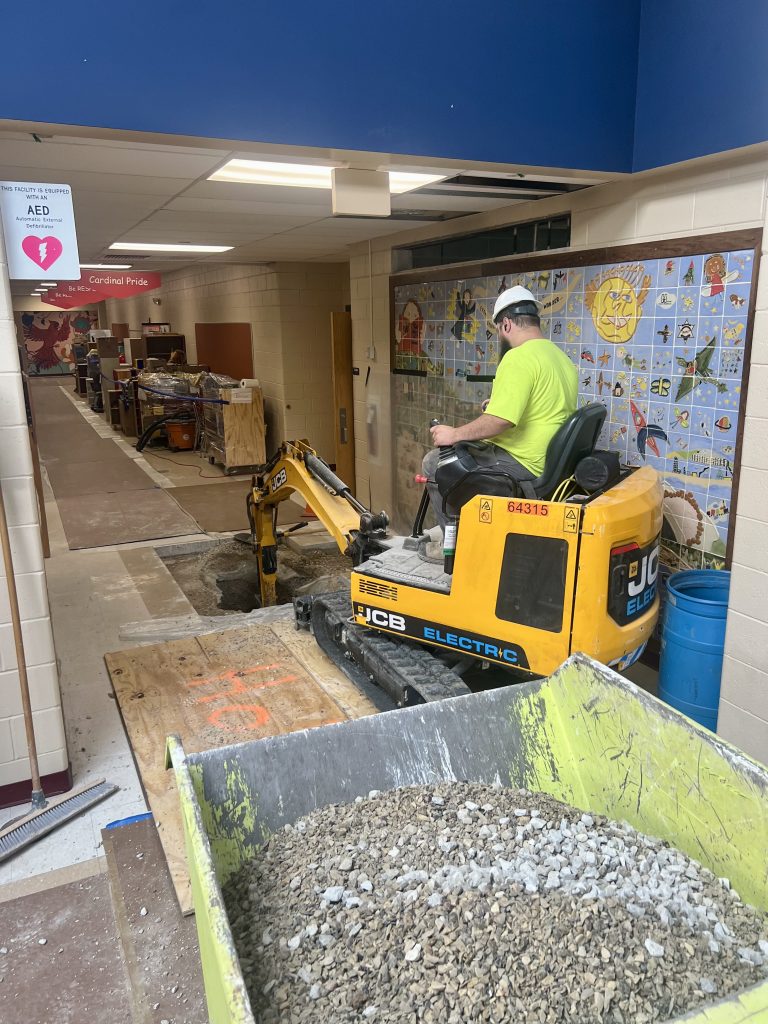

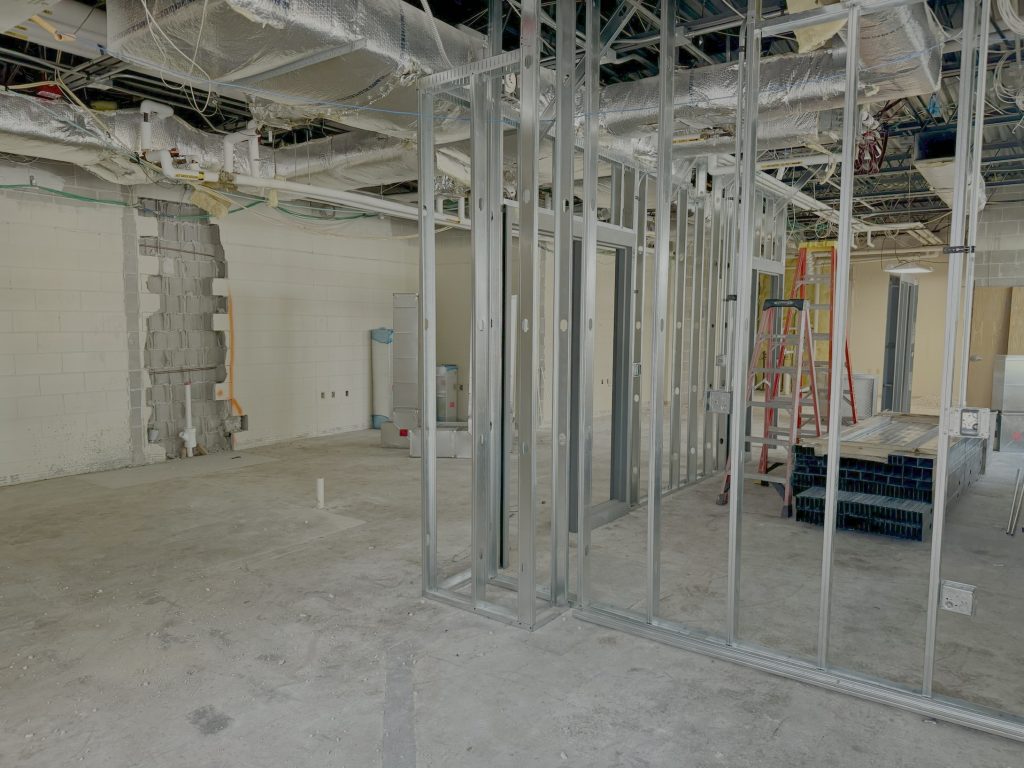

- Watch July 2025 Lannon Elementary Project Update

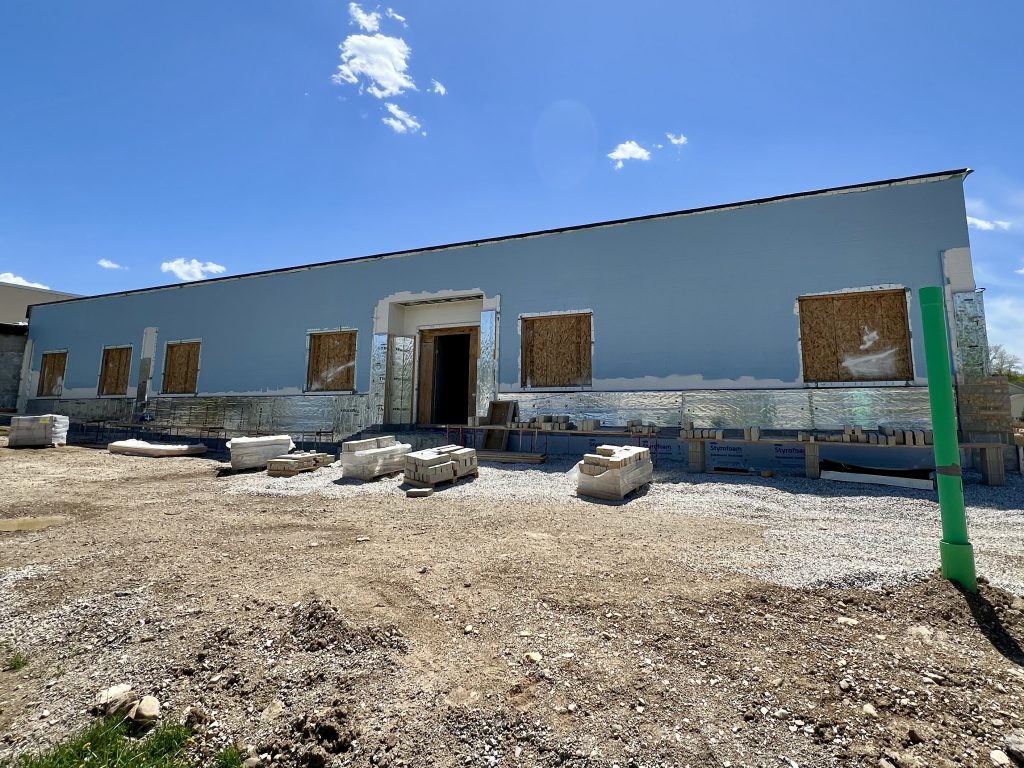

- May 2025 – roofing complete, Lannon stone veneer exterior

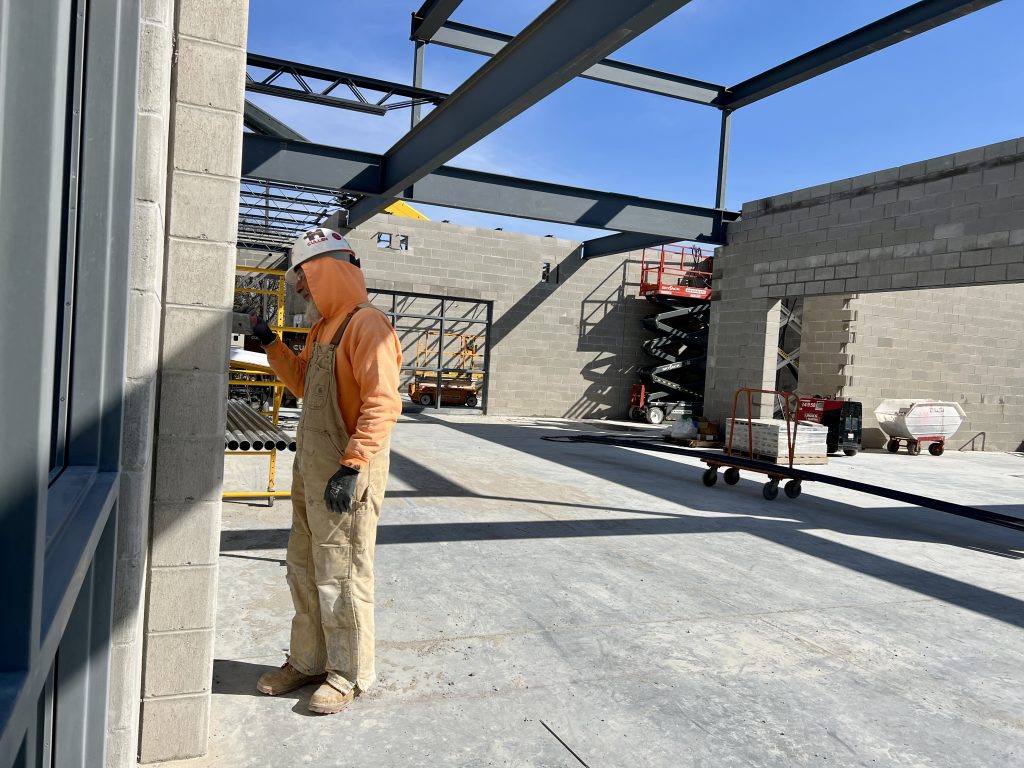

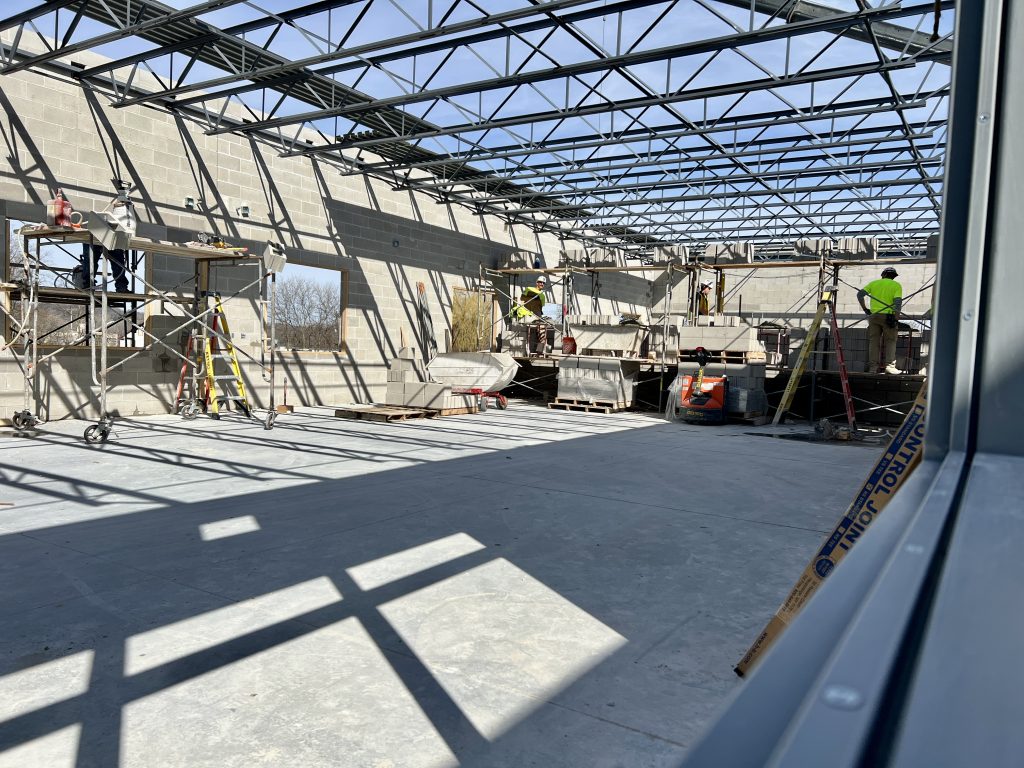

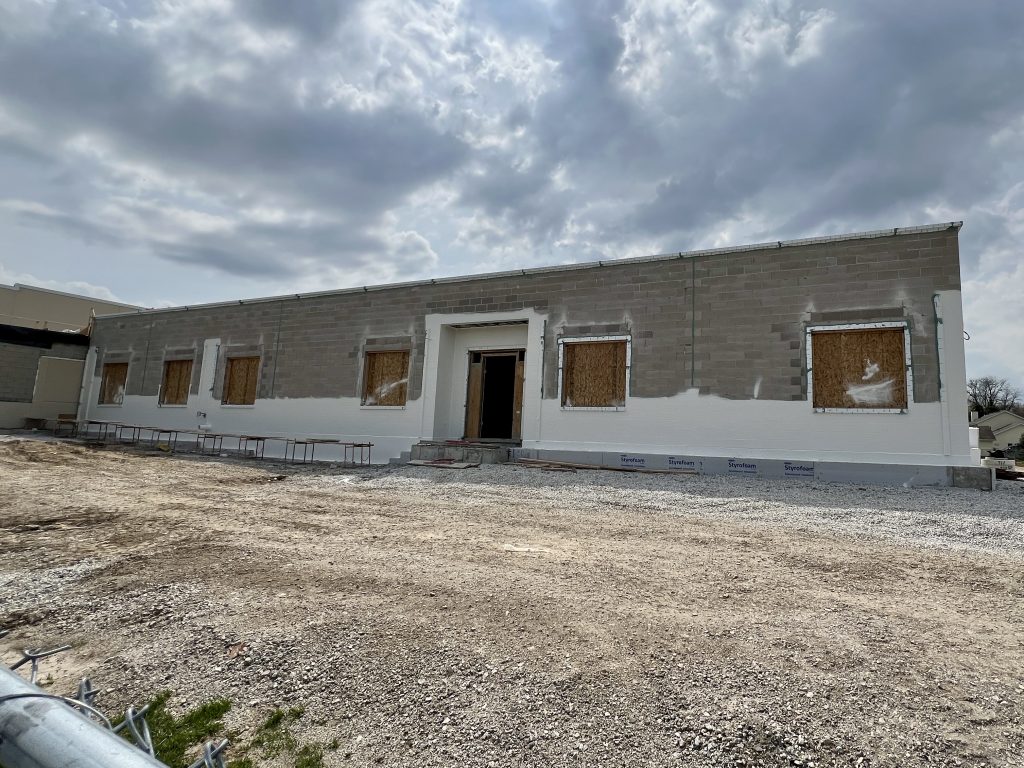

- Watch April 2025 Lannon Elementary Project Update

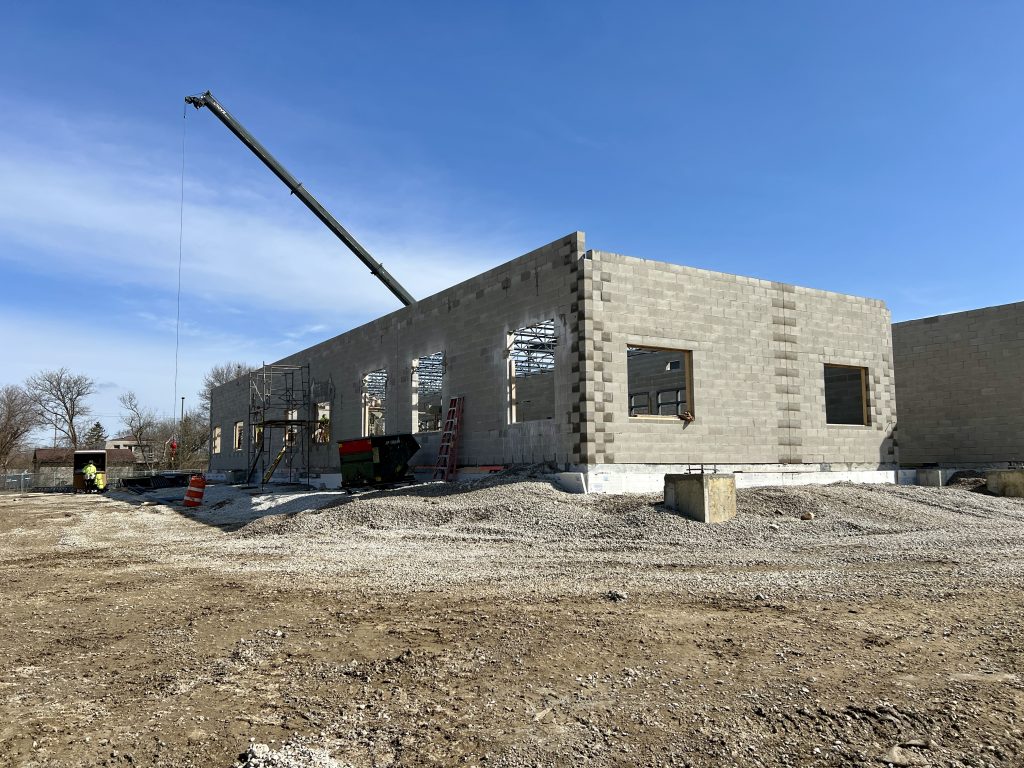

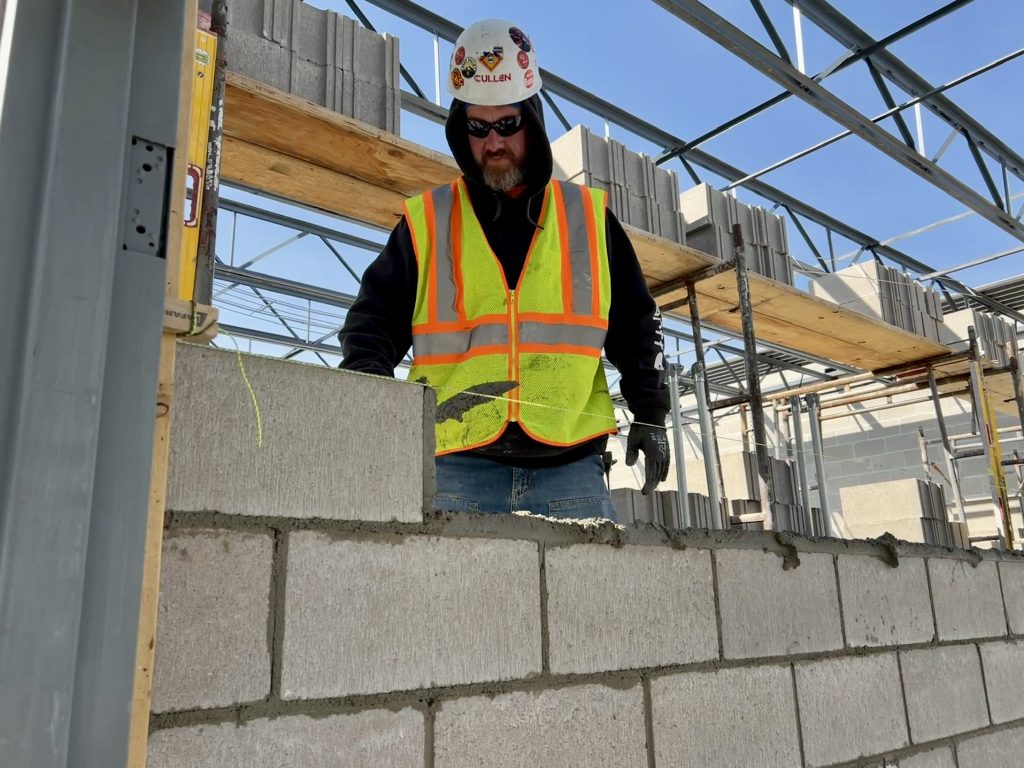

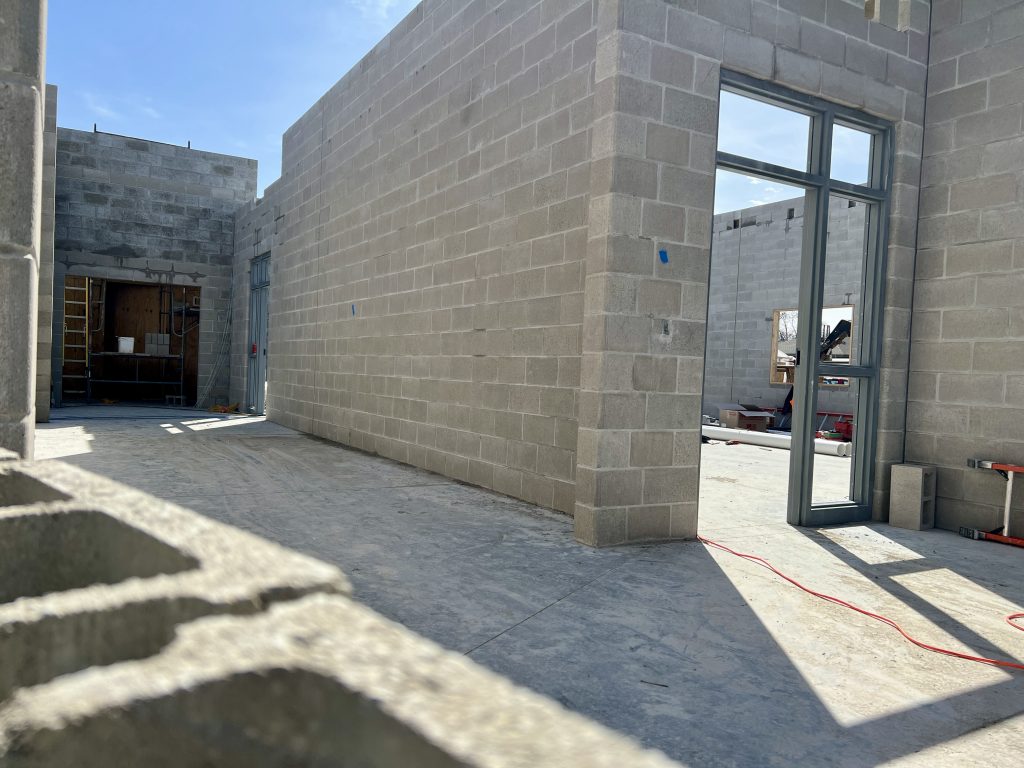

- April 2025 – roof decking, insulation, beginning electrical and fire
- March 2025 – interior footings poured, interior walls built, playground removed/stored

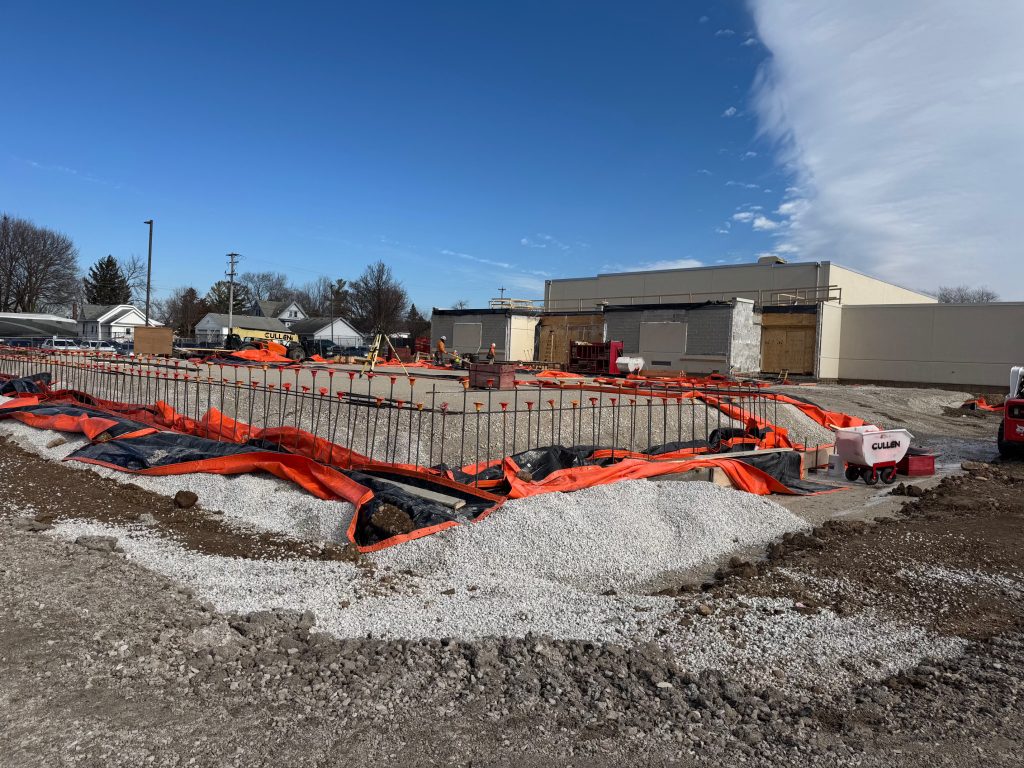

- Feb. 2025 – foundation and walls poured, retention ponds built
- Jan. 2025 – demolition, footings and foundation poured




You are invited to review the project overview document for additional information.

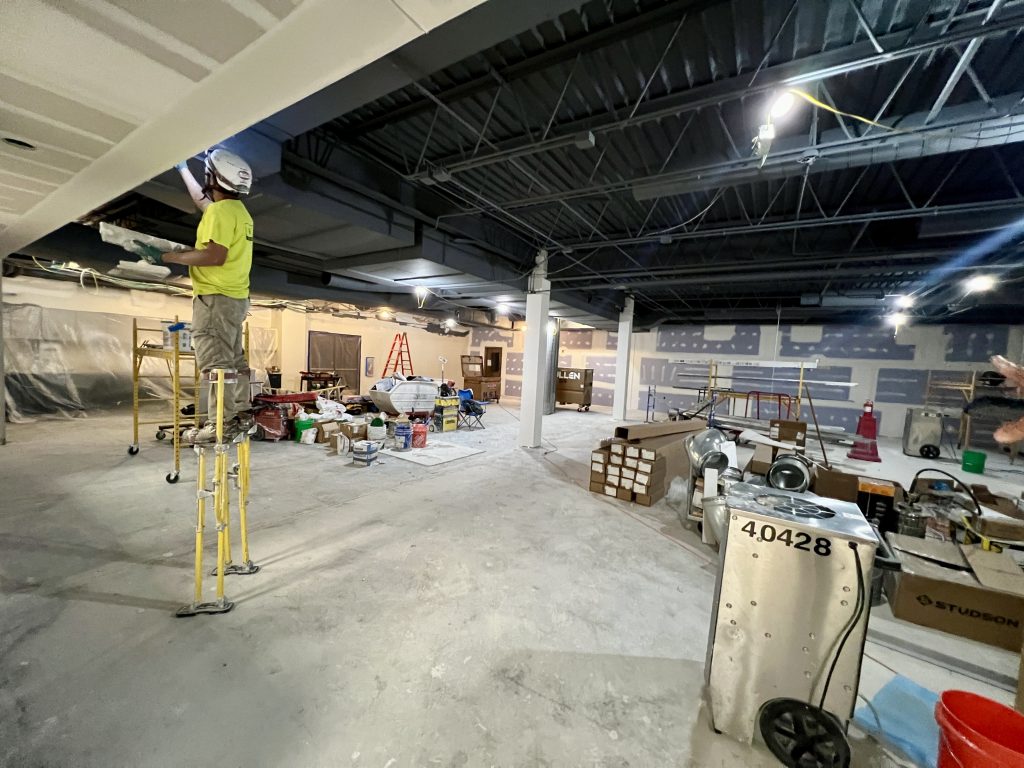

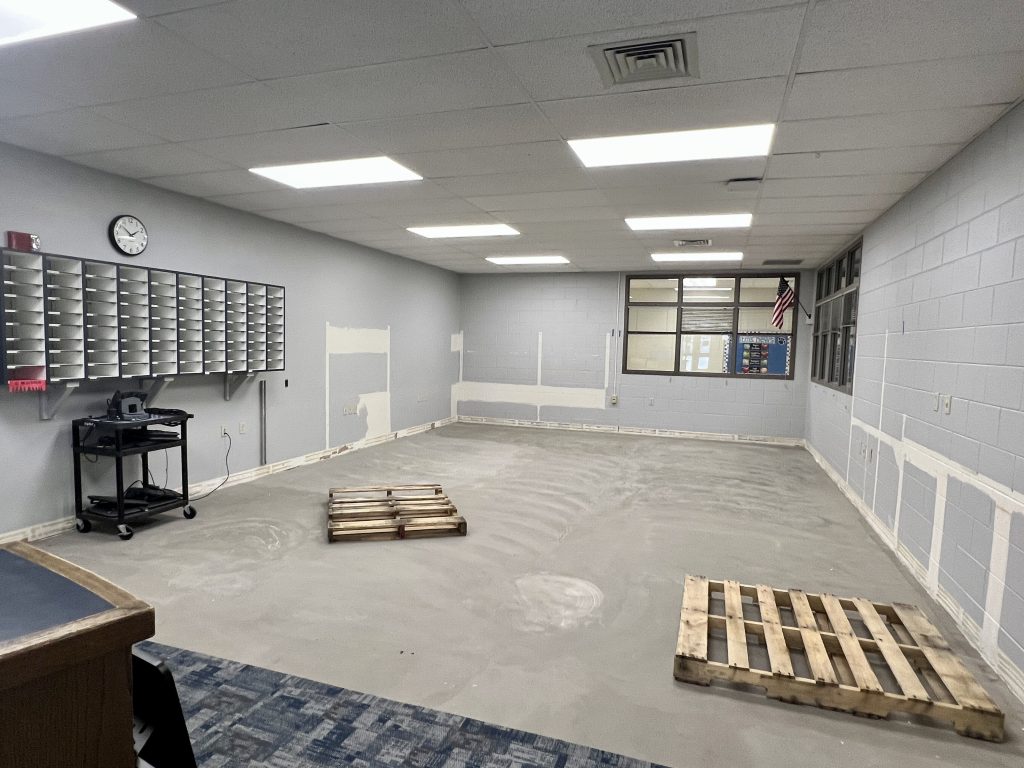

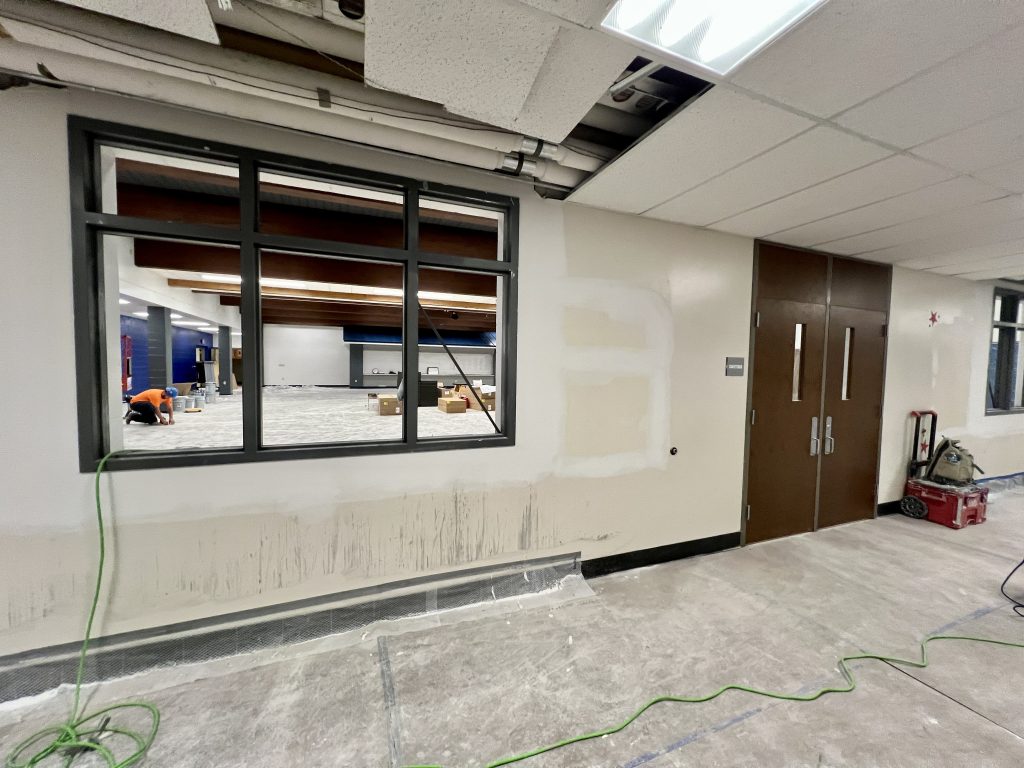

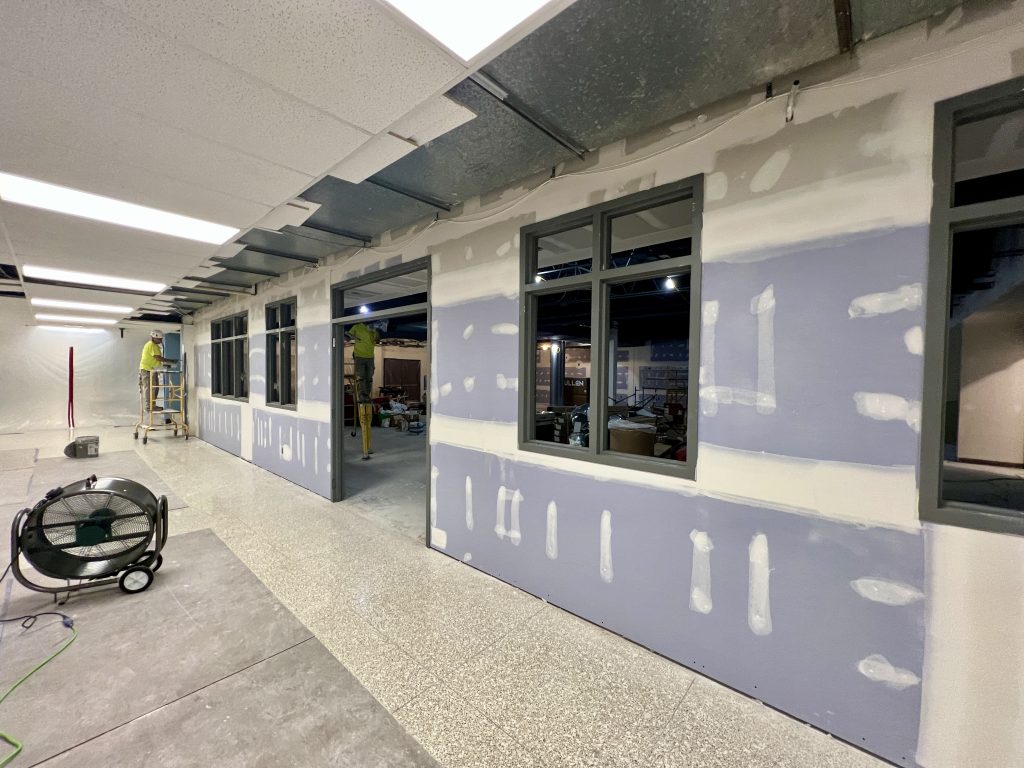

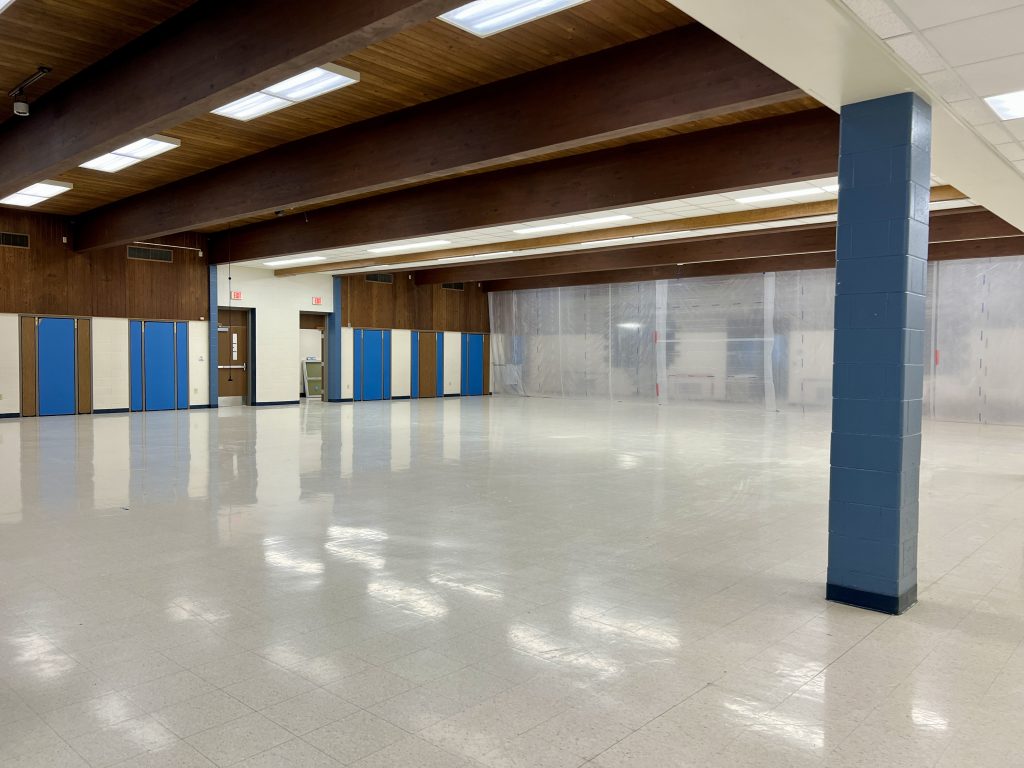

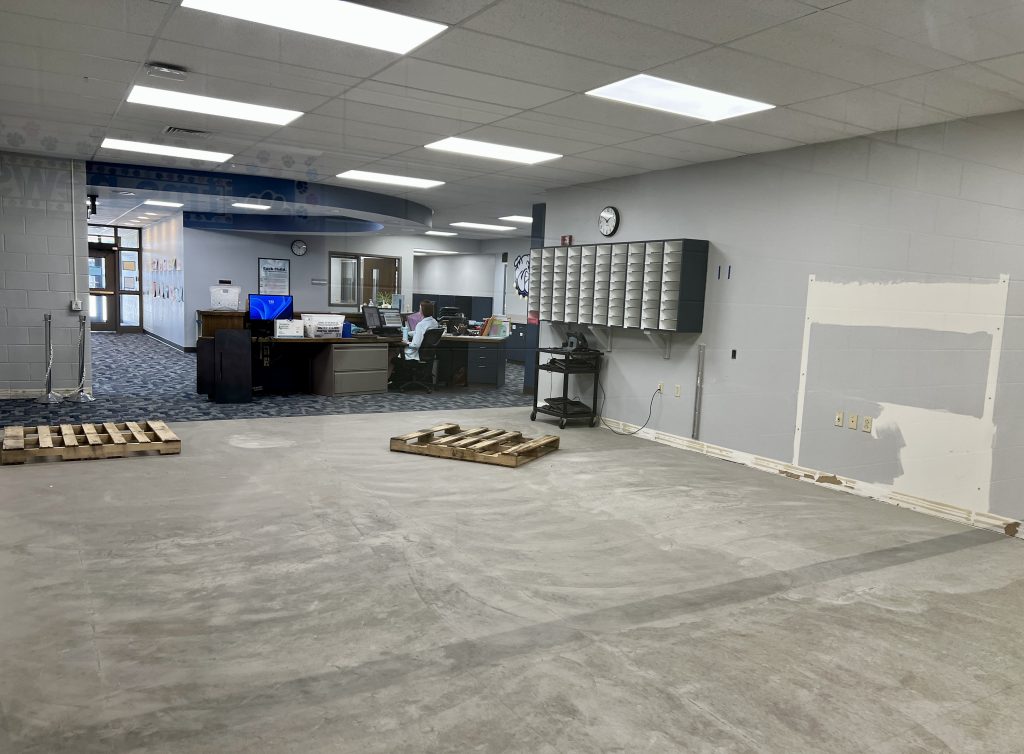

Templeton Middle School cafeteria * PROJECT COMPLETE *
June 2025 – August 2025
Scheduled to be complete before the 2025-26 school year begins

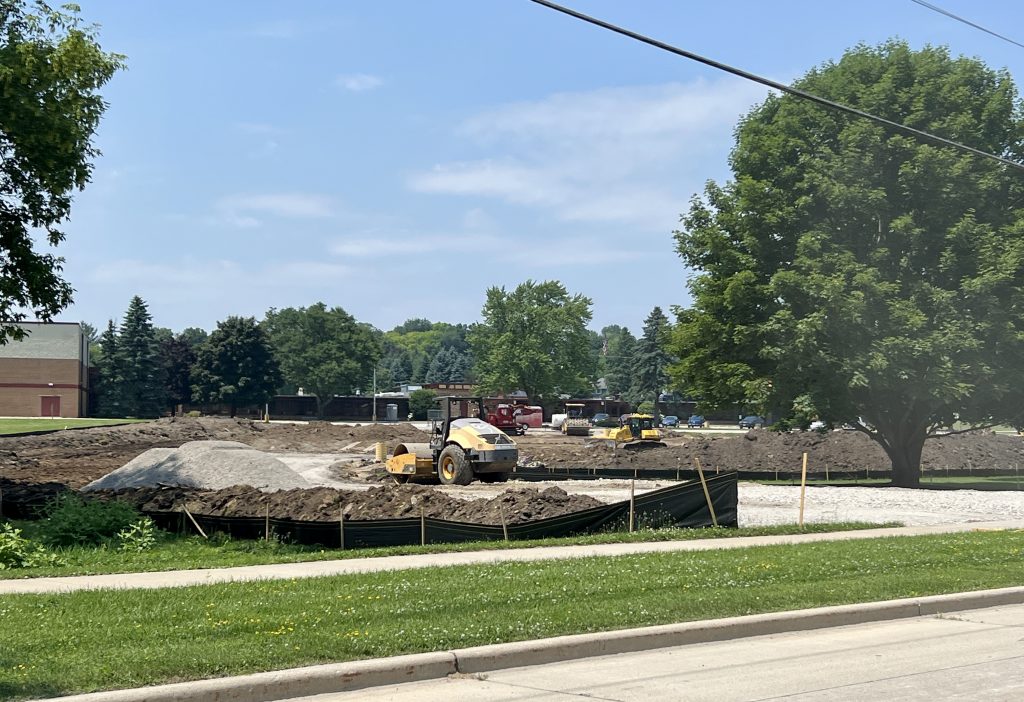

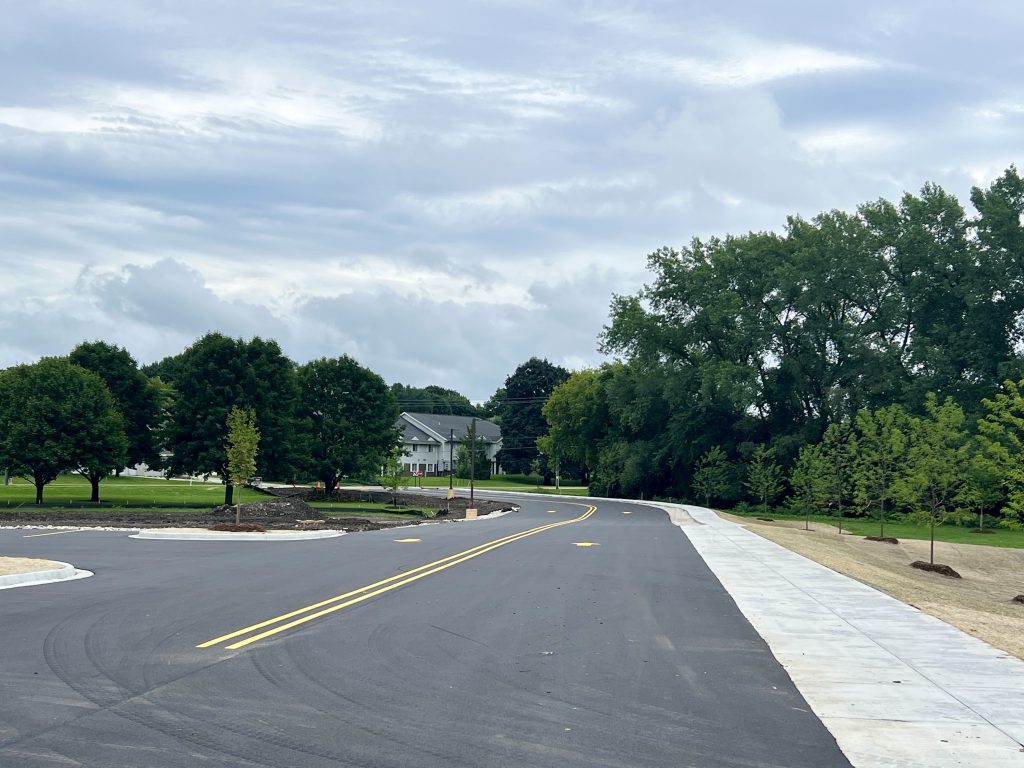

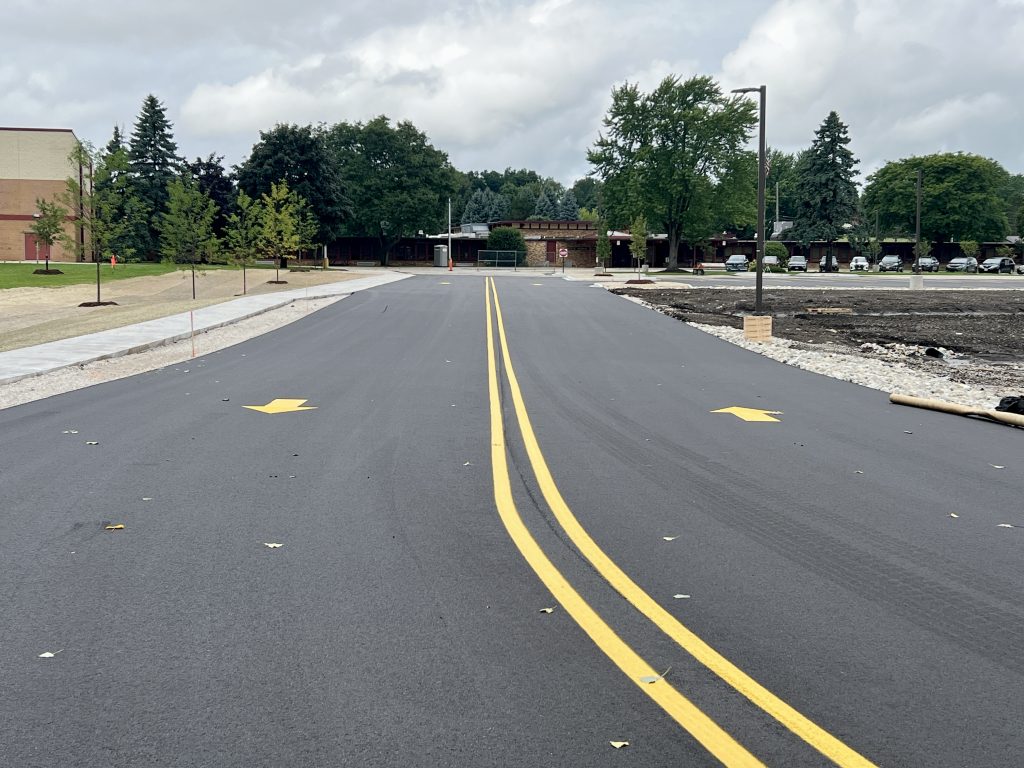

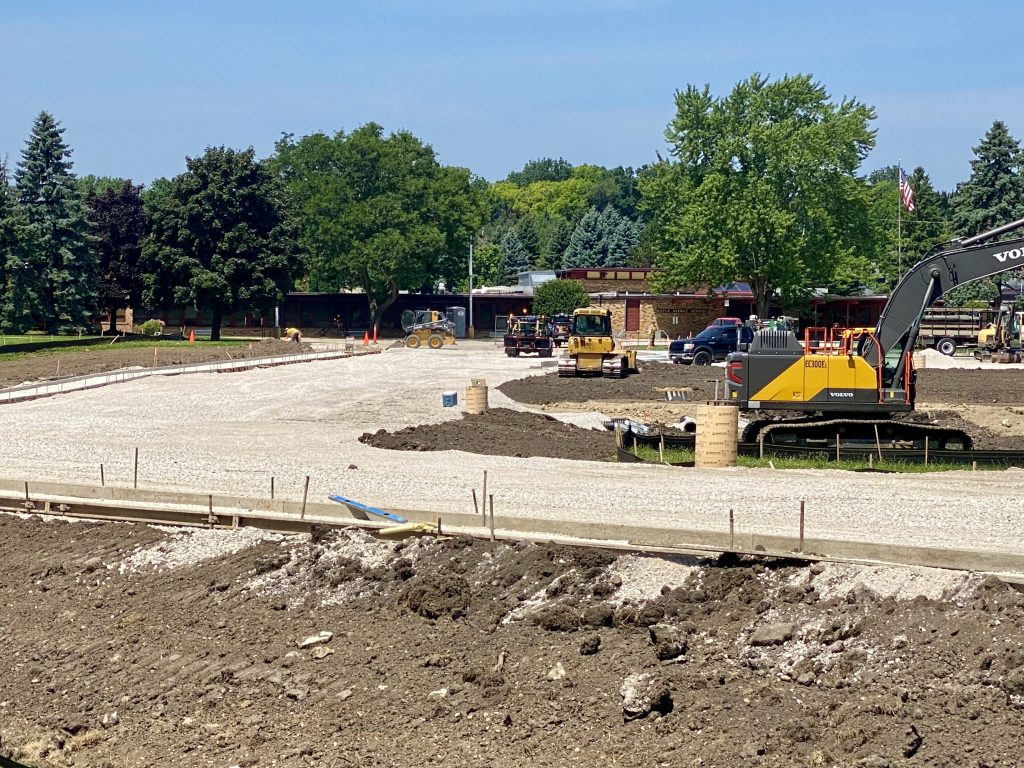

Maple Ave. Elementary School traffic reconfiguration * PROJECT COMPLETE *

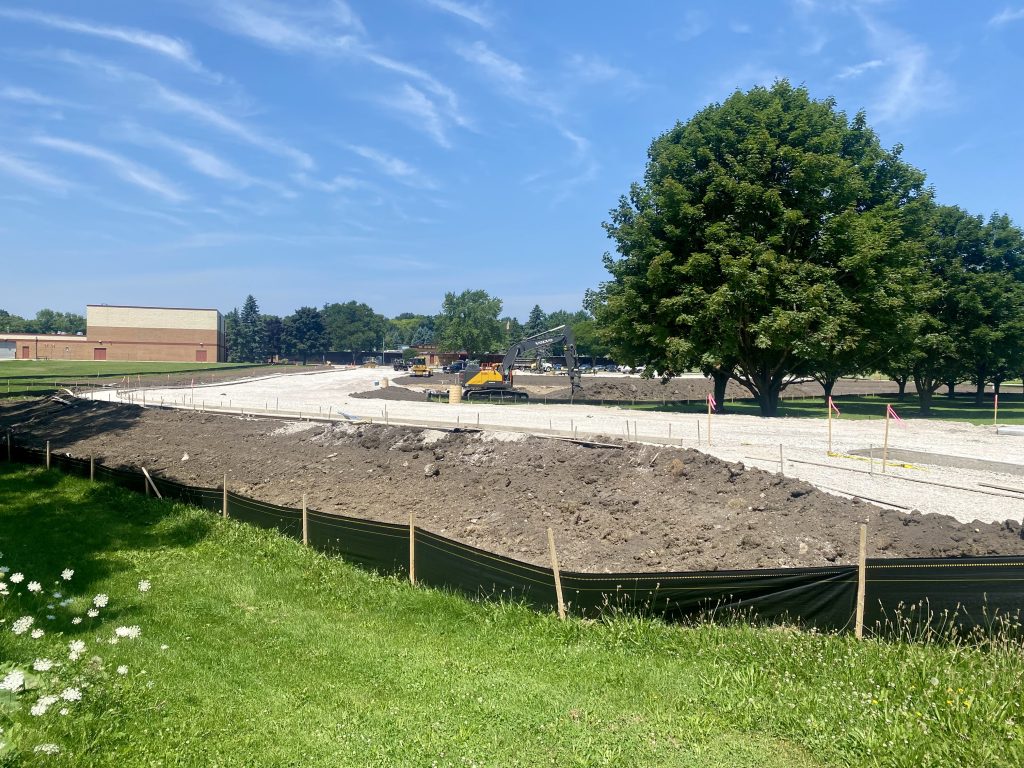

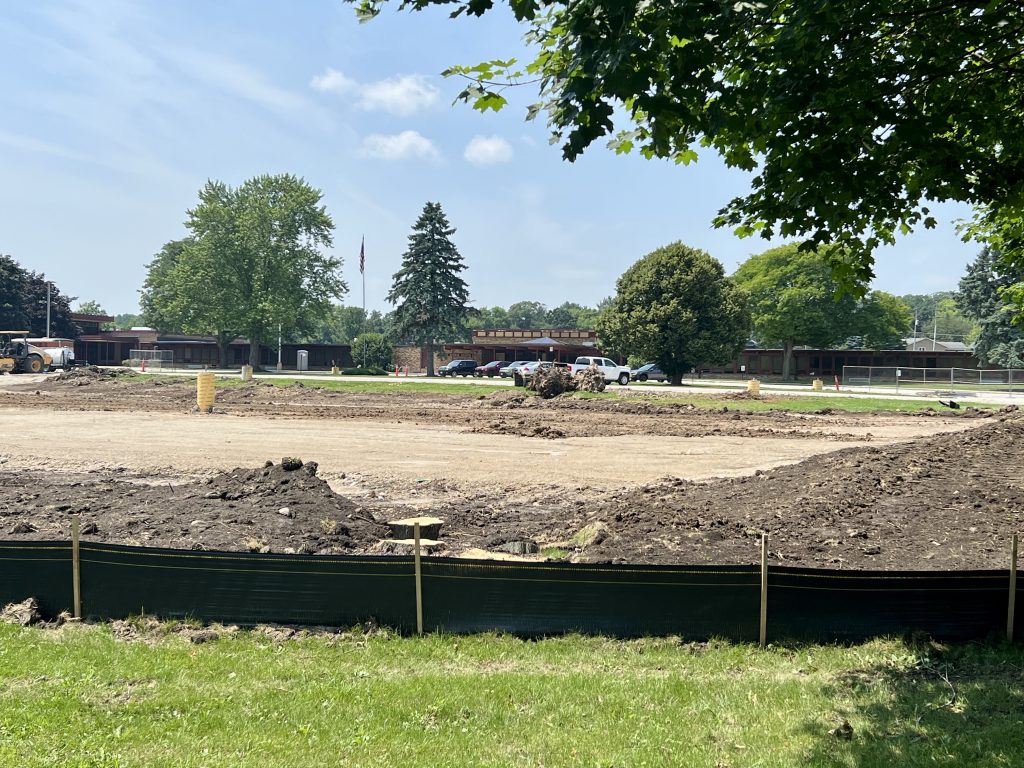

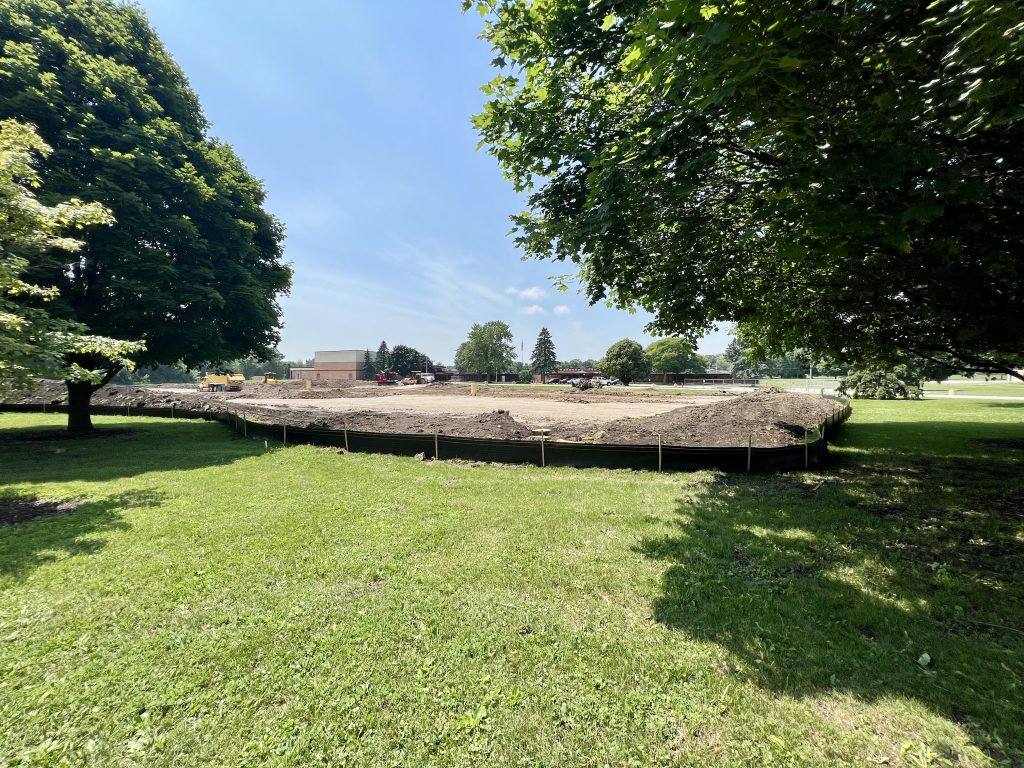

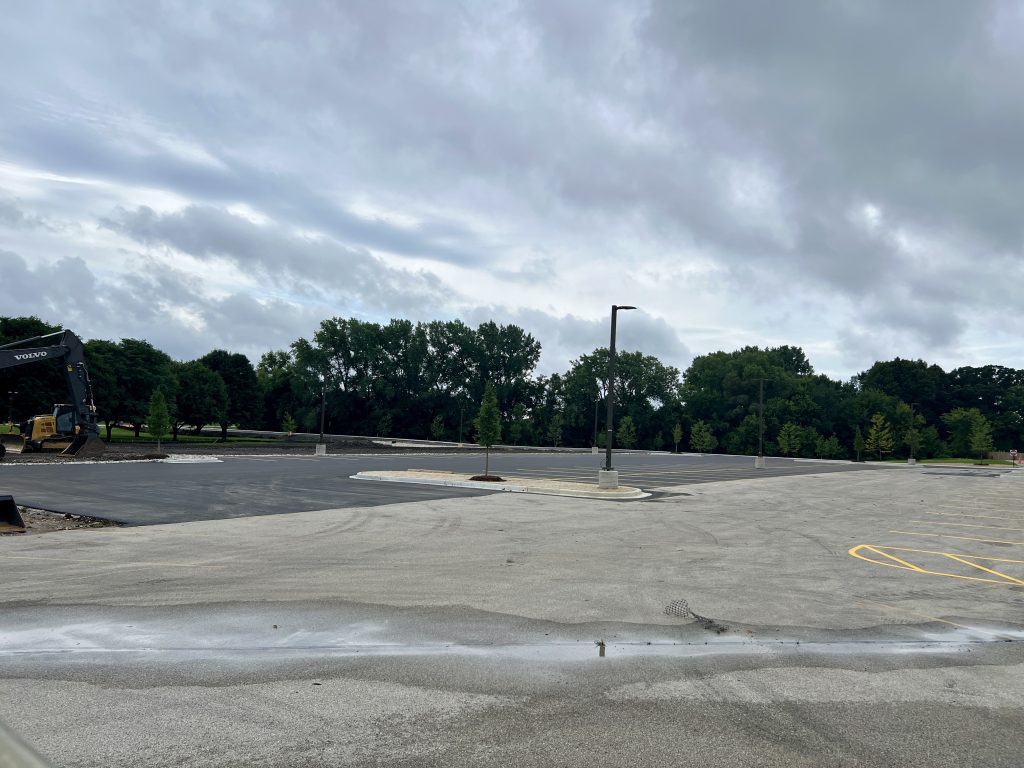

June 2025 – August 2025
Scheduled to be complete before the 2025-26 year begins

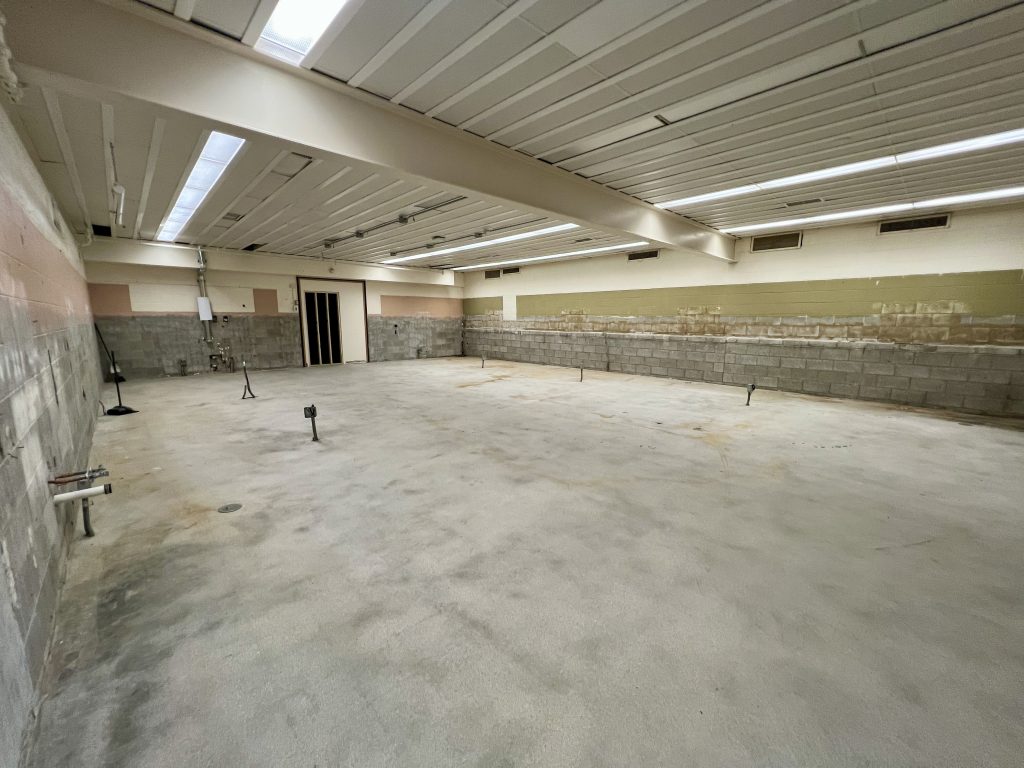

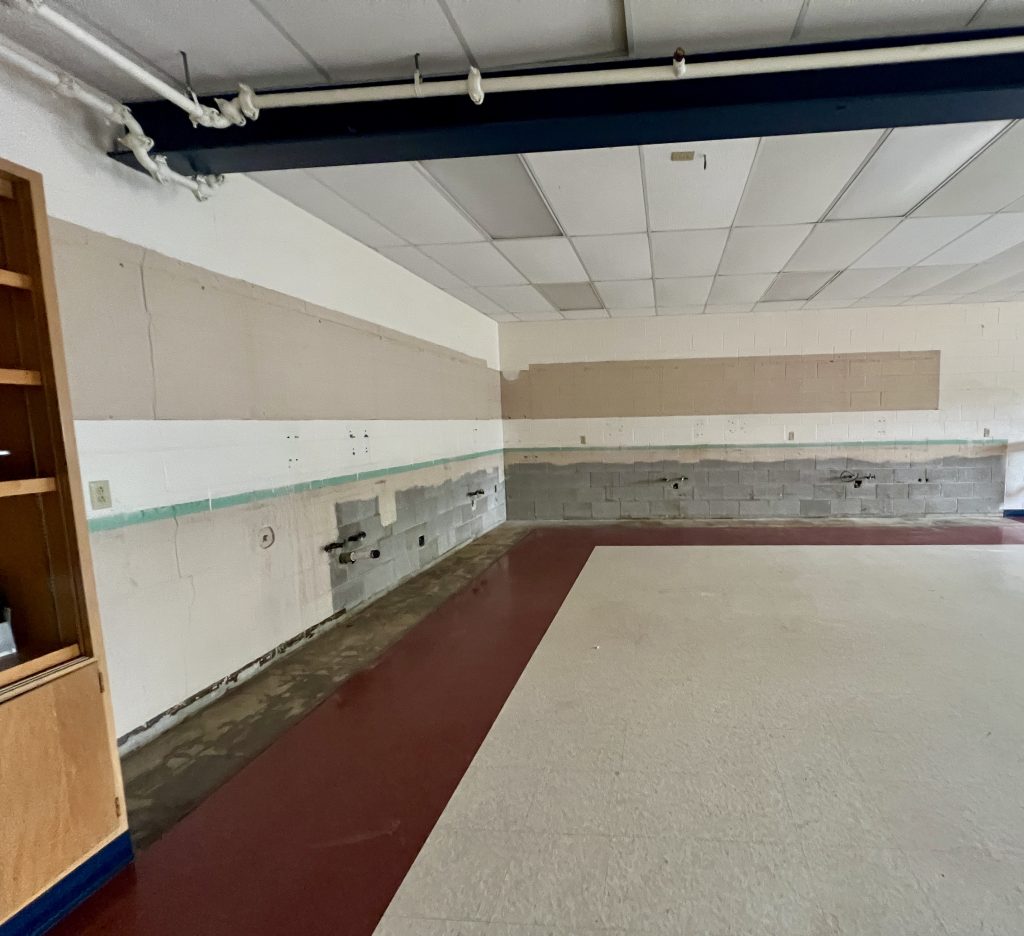

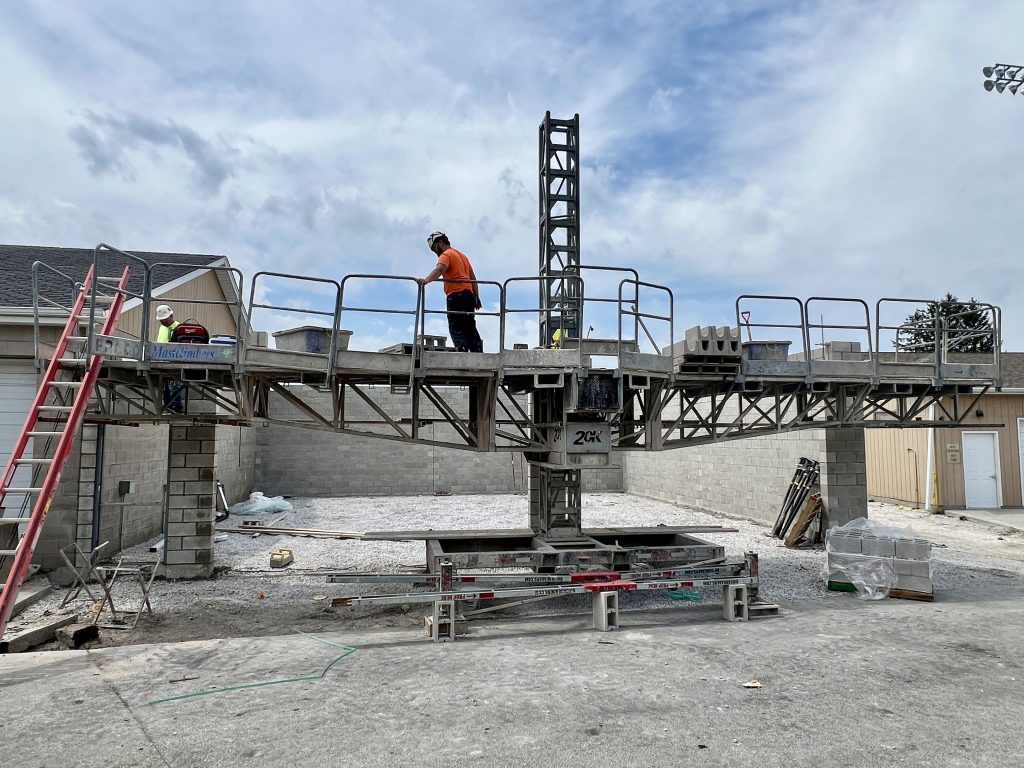

Hamilton High School classroom renovations *PROJECT COMPLETE*
June 2025 – August 2025
